New Stettiner Strasse daycare center 2021

New construction of a four-group daycare center, awarded as "Energy-efficient non-residential building NRW"

This project has been completed.
General view of the building

Occasion and goal

There was a single-storey pavilion building on the site at Stettiner Strasse 16, which was used as a 1-group daycare center. Now there is a new two-storey building with 4 groups to replace the old building. During the construction period, the daycare center was relocated to the Schwalbenweg elementary school.

  • Key data

    • New building completion 2021
    • 4-group daycare center (70 places with 20 places U3, 50 places Ü3)
    • Efficient use of daylight thanks to south-facing orientation
    • High energy efficiency (heat pump, ventilation system with heat recovery and PV system)
    • Net room area NRF: approx. 703 m²
    • Start of implementation: Winter 2018
    • Completion date: summer 2020
    • Funds required: € 3.02 million
    • Architects: Herkrath + Herkrath Architekten PartGmbB, Aachen
  • Awards 2025 as an energy-efficient non-residential building

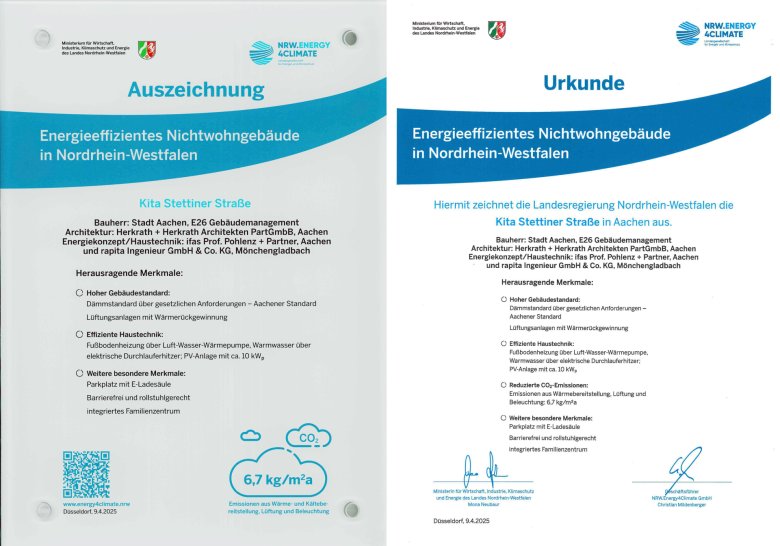

    Award and certificate for KiTa Stettiner Straße
    Award and certificate for KiTa Stettiner Straße
    Presentation of the award, from left to right: Gabriele Hajok (Head of Facility Management), Ms. Herkrath (Herkrath + Herkrath Architekten PartGmbB), Jens Hausschild (Head of Facility Management), Leonidas Papadopoulos (Project Manager Facility Management), Mr. Petersdorff (Ministry MWIKE NRW) Silke Krebs (State Secretary Ministry MWIKE NRW), Heiko Thomas (Department of Environment City of Aachen)
    Presentation of the award, from left to right: Gabriele Hajok (Head of Facility Management), Ms. Herkrath (Herkrath + Herkrath Architekten PartGmbB), Jens Hausschild (Head of Facility Management), Leonidas Papadopoulos (Project Manager Facility Management), Mr. Petersdorff (Ministry MWIKE NRW) Silke Krebs (State Secretary Ministry MWIKE NRW), Heiko Thomas (Department of Environment City of Aachen)

Construction site photos

  • 21.05.2022 Inauguration ceremony

    Welcome
    Stock photo
    The daycare center was colorfully decorated for the inauguration ceremony.
    The daycare center was colorfully decorated for the inauguration ceremony.
  • 2020 Completion photos

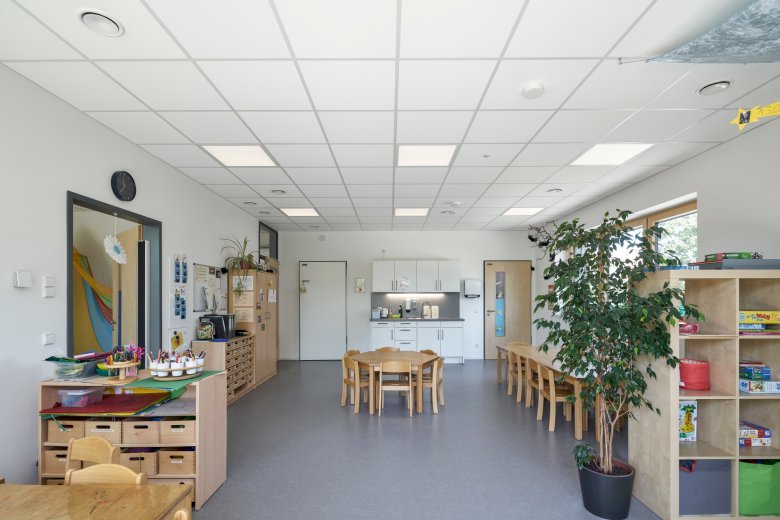

    Kita_Stettiner_Str_c_A_Horsky_2021 (14)
    Kita_Stettiner_Str_c_A_Horsky_2021 (13)
    Kita_Stettiner_Str_c_A_Horsky_2021 (12)
    Kita_Stettiner_Str_c_A_Horsky_2021 (9)
    Kita_Stettiner_Str_c_A_Horsky_2021 (10)
    Kita_Stettiner_Str_c_A_Horsky_2021 (11)
    Kita_Stettiner_Str_c_A_Horsky_2021 (8)
    Kita_Stettiner_Str_c_A_Horsky_2021 (15)
    Kita_Stettiner_Str_c_A_Horsky_2021 (4)
    Kita_Stettiner_Str_c_A_Horsky_2021 (3)
    Kita_Stettiner_Str_c_A_Horsky_2021a
    Kita_Stettiner_Str_c_A_Horsky_2021
    Completion photos by A. Horsky
  • January 2021

    Eingang_Fertig_c_E26_2021_03
  • December 2020

    The new planting has taken place.
    The new planting has taken place.
  • November 2020

    The plants were delivered.
    The plants were delivered.
  • October 2020

    The bike racks are delivered and installed.
    The bike racks are delivered and installed.
    The bicycle parking area has been completed.
    The bicycle parking area has been completed.
    Zaun_Außenanlage_c_E26_2020_10

    The fence and railings are installed.
    The fence and railings are installed.
  • September 2020

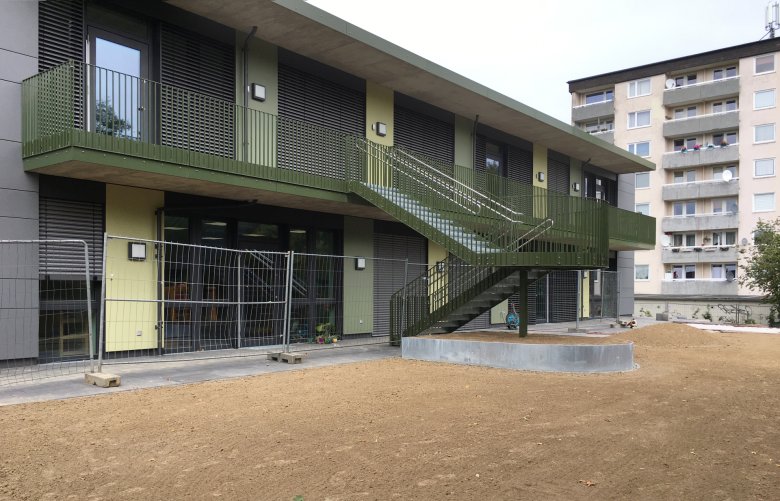

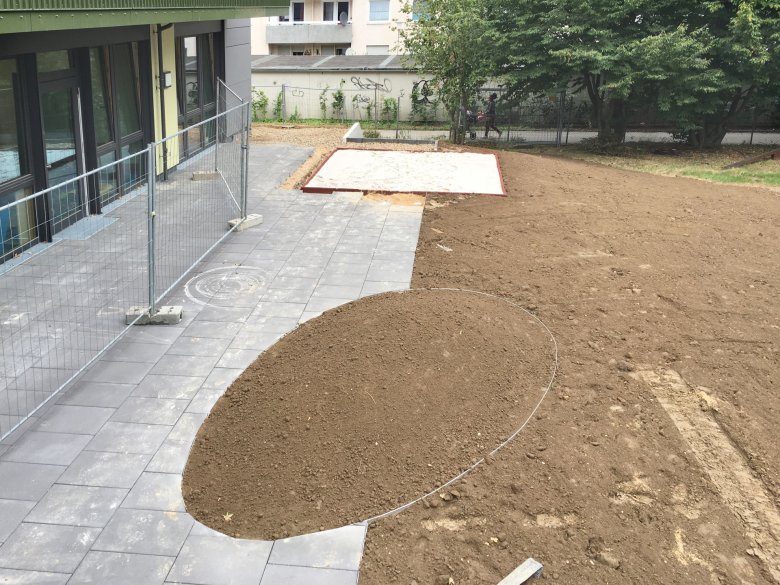

    The outdoor storage building was delivered and assembled.
    The outdoor storage building was delivered and assembled.

    The passageway for the fire department has been completed.
    The passageway for the fire department has been completed.
    The playhouse and sandpit for the U3 area have been completed. The sunshade for the sandpit has been delivered and installed.
    The playhouse and sandpit for the U3 area have been completed. The sunshade for the sandpit has been delivered and installed.
    The outdoor work is progressing. The sandpit has been completed.
    The outdoor work is progressing. The sandpit has been completed.
    The construction of the outdoor facilities is progressing.
    The construction of the outdoor facilities is progressing.

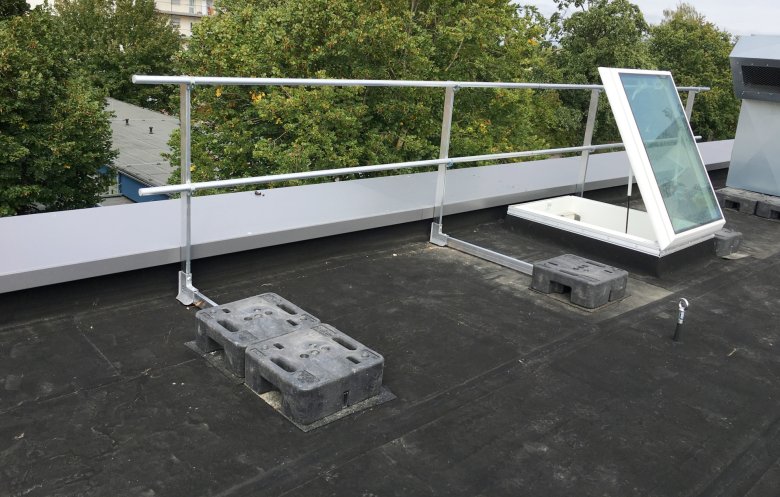

    The fall protection on the roof was installed.
    The fall protection on the roof was installed.

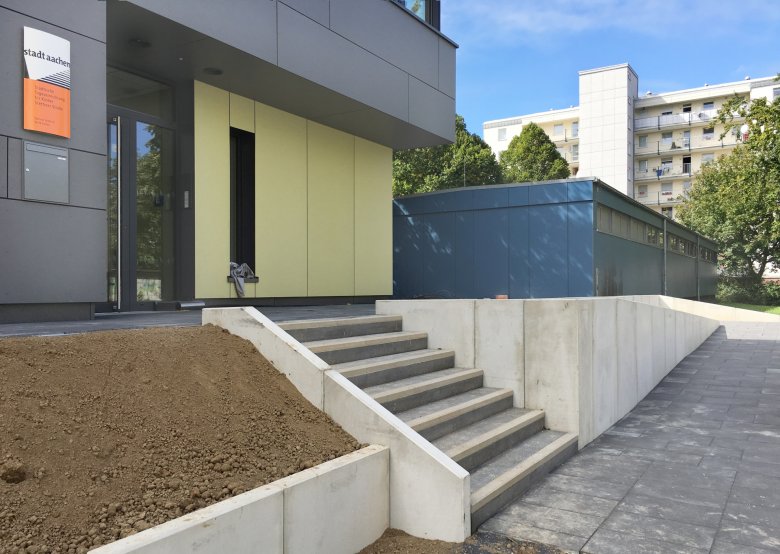

    The ramp is finished.
    The ramp is finished.
    Work on the ramp and the entrance is progressing.
    Work on the ramp and the entrance is progressing.
  • August 2020

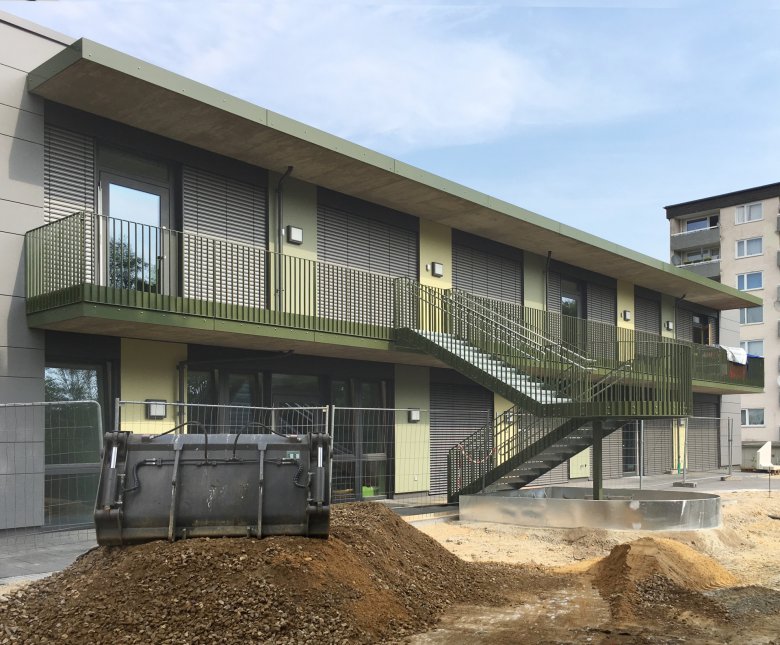

    Treppe_Baggerschaufel_c_E26_2020_08

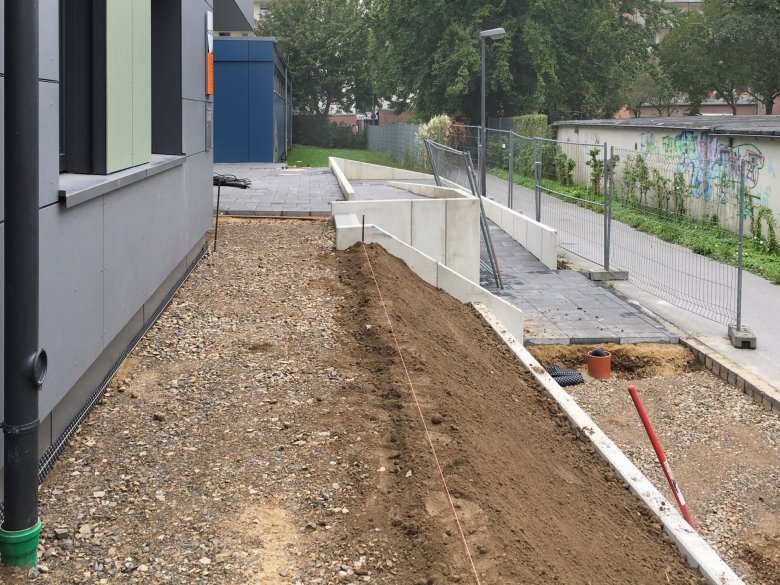

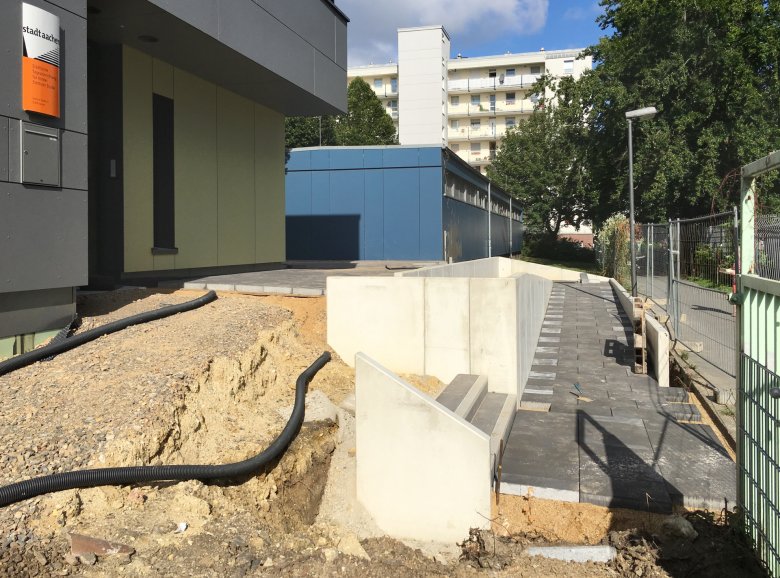

    The exterior work is progressing. The ramp is being built.
    The exterior work is progressing. The ramp is being built.
  • July 2020

    The exterior work is progressing.

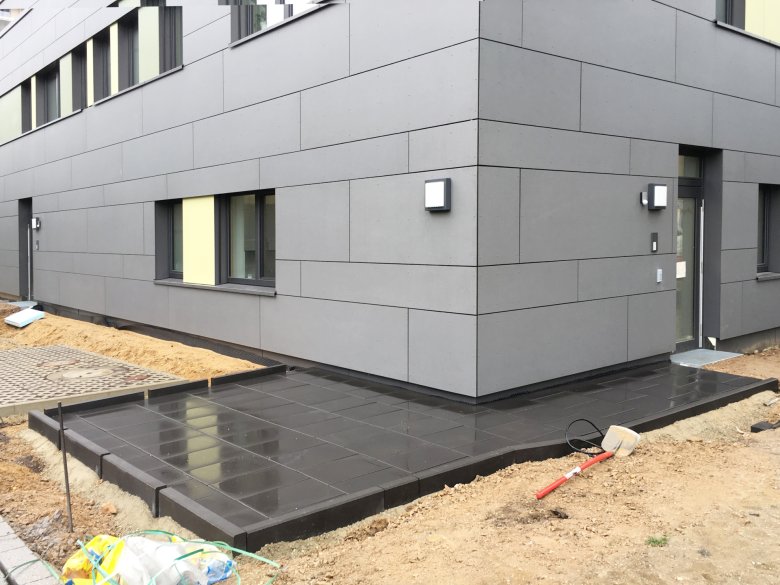

    The exterior work is progressing.

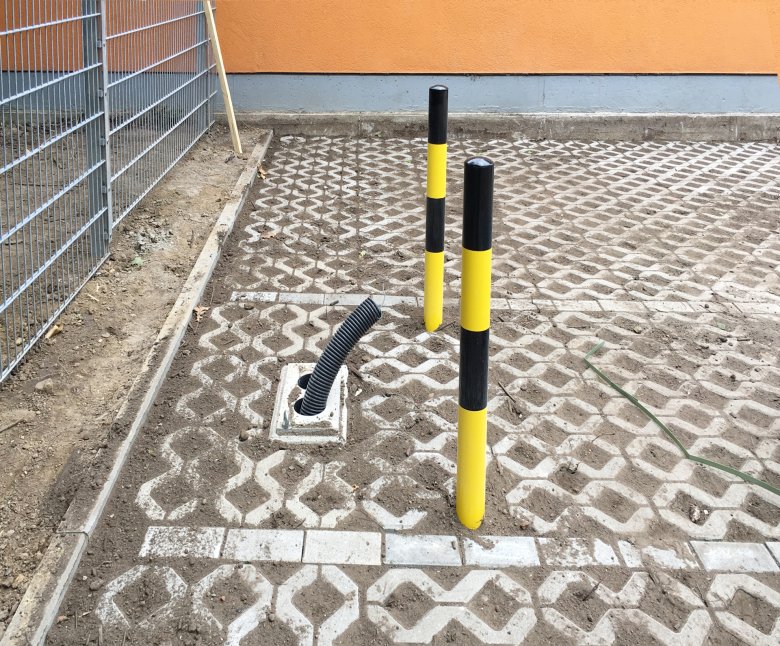

    The preparations for the e-pillar have been completed.
    The preparations for the e-pillar have been completed.
    The KiTa sign has been installed
    The KiTa sign has been installed

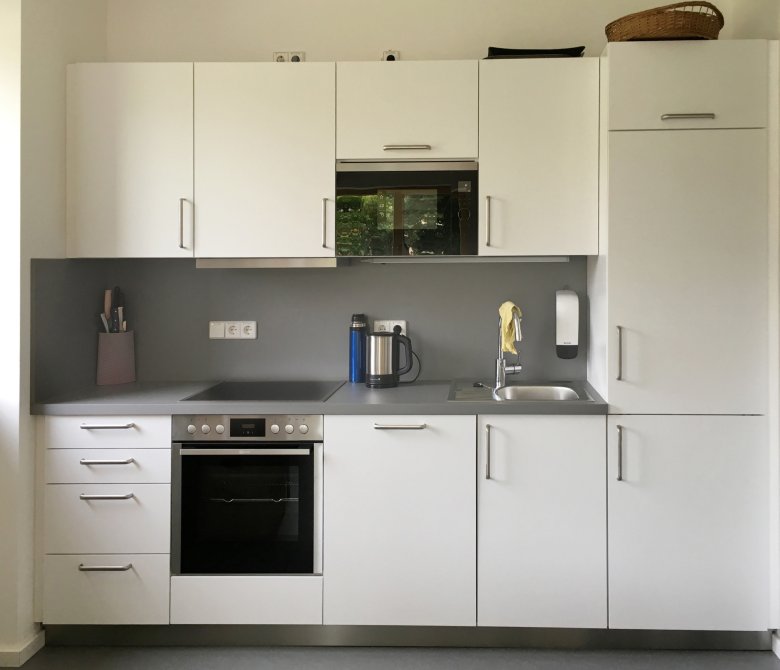

    The staff kitchen has been completed.
    The staff kitchen has been completed.
    The checkrooms are ready.

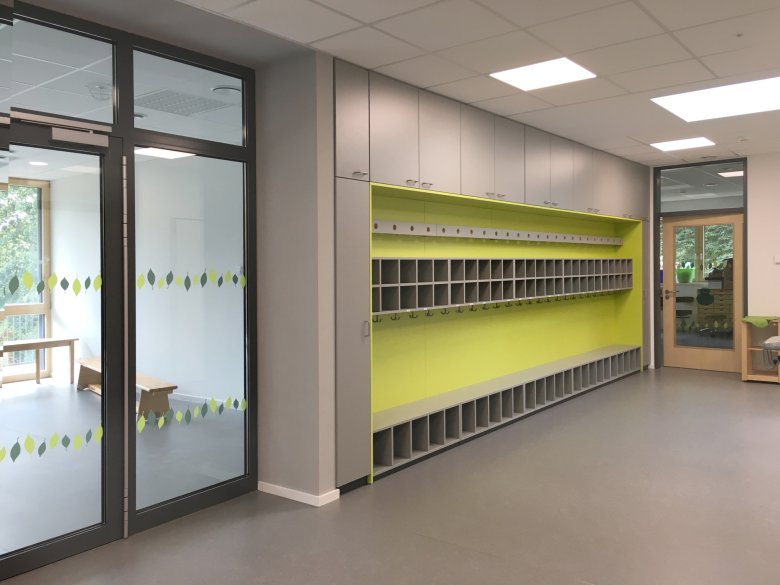

    The checkrooms are ready.
    Gaderobe_Vortgeschritten_c_E26_2020_07

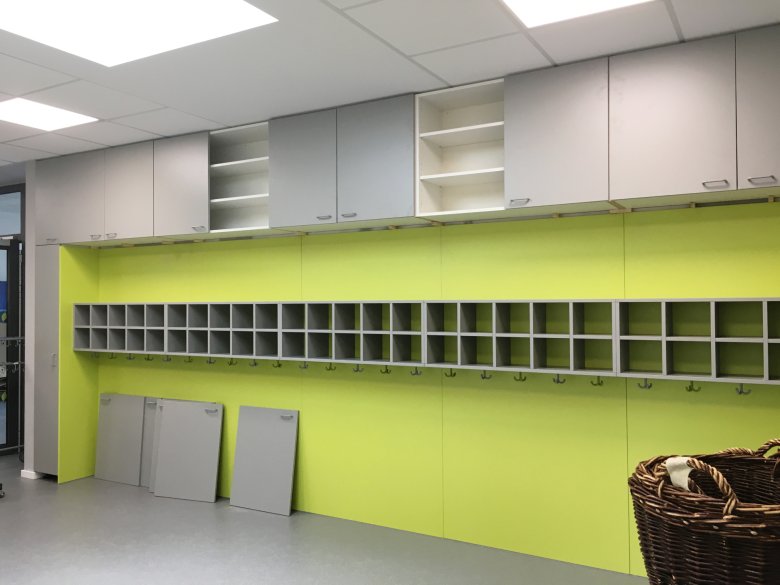

    The wardrobes have been delivered and are being installed.
    The wardrobes have been delivered and are being installed.
  • June 2020

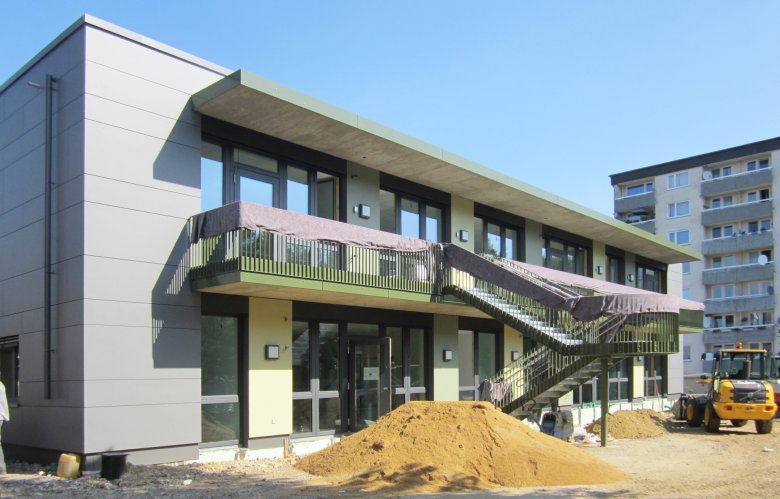

    The exterior work has begun.
    The exterior work has begun.

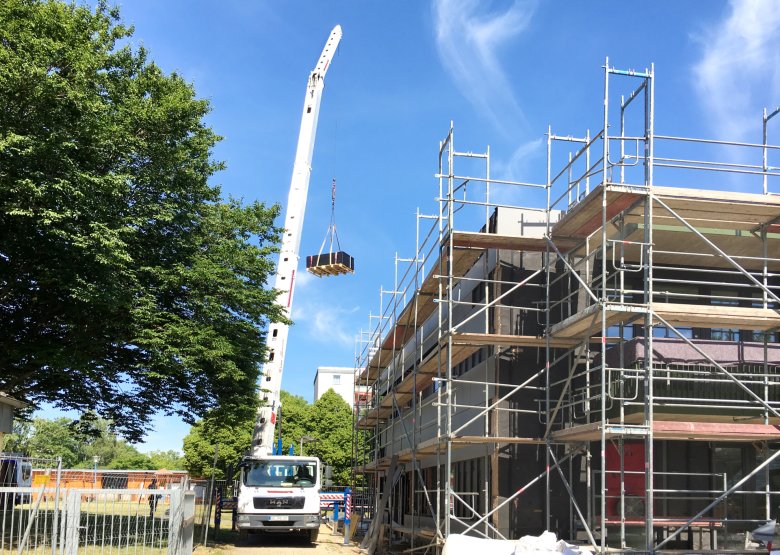

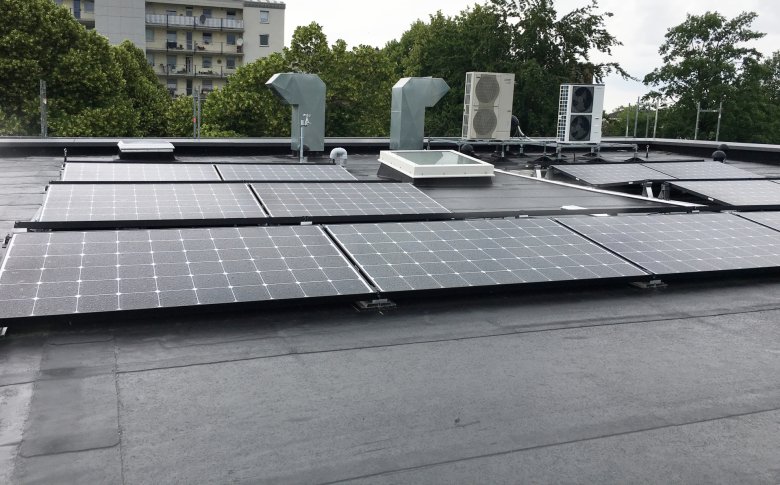

    The PV system has been installed.
    The PV system has been installed.
    The PV system was delivered
    The PV system was delivered

    The staff kitchen has been delivered and is being installed.
    The staff kitchen has been delivered and is being installed.

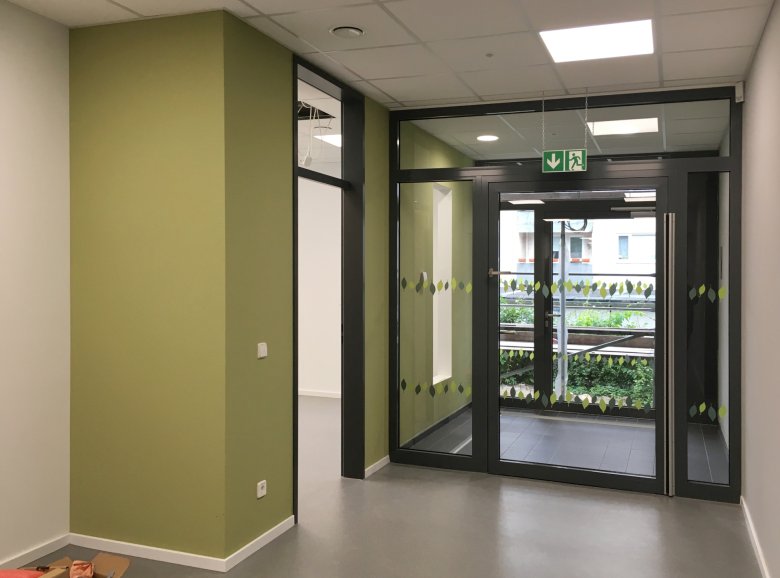

    The group rooms have been completed.
    The group rooms have been completed.

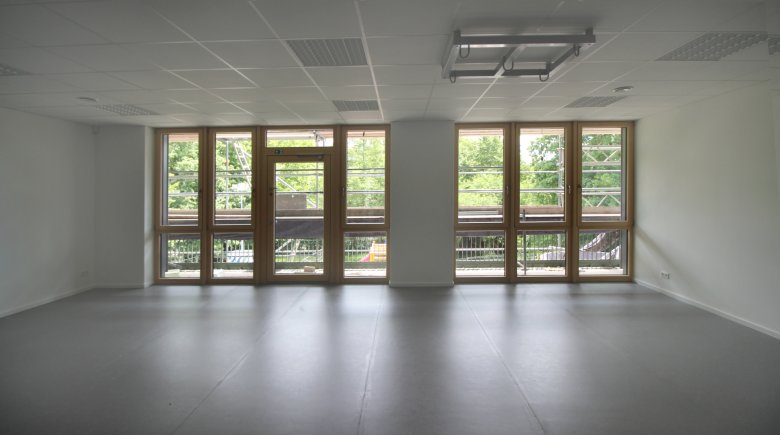

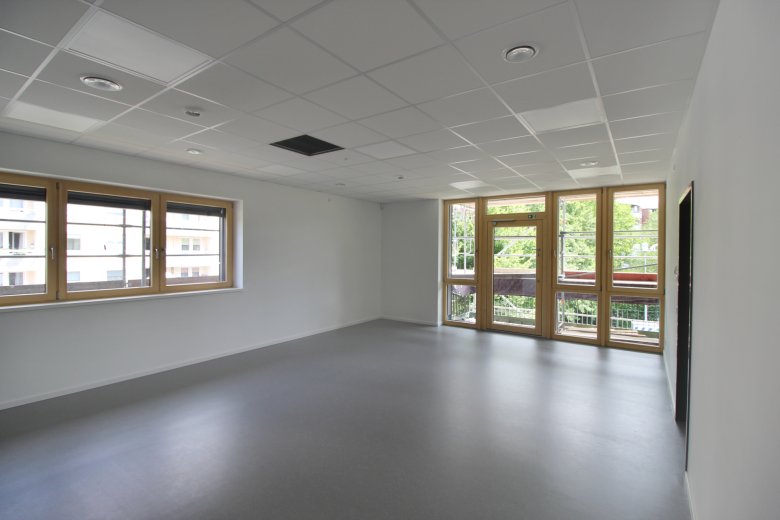

    Mehrzweckraum_Fenster_c_E26_2020_06
    Mehrzweckraum_Tür_Innen_c_E26_2020_06

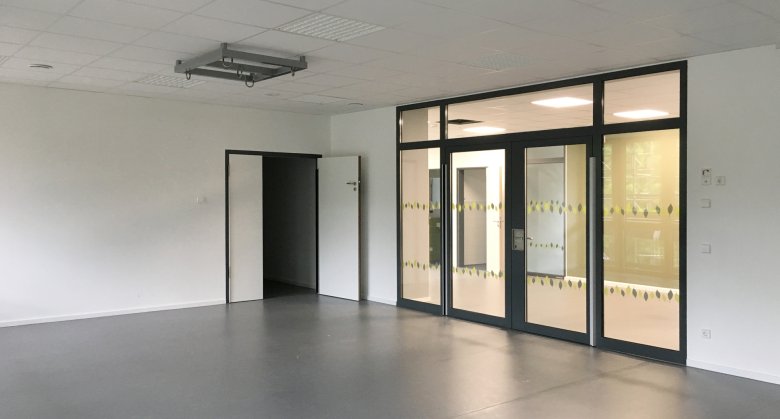

    The multi-purpose room was completed.
    The multi-purpose room was completed.
    The corridors are ready for furnishing. The group rooms have been completed.
    The corridors are ready for furnishing. The group rooms have been completed.
  • May 2020

    Elevator
    Elevator

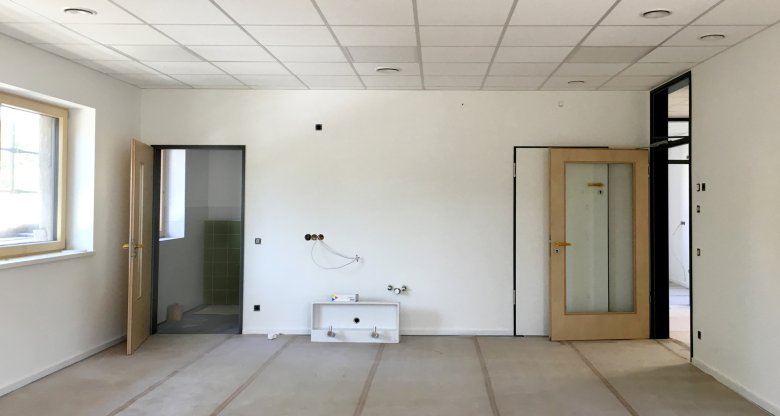

    The final electrical installation is taking place. The lamps have been installed.
    The final electrical installation is taking place. The lamps have been installed.
    The impact protection in the multi-purpose room was installed.

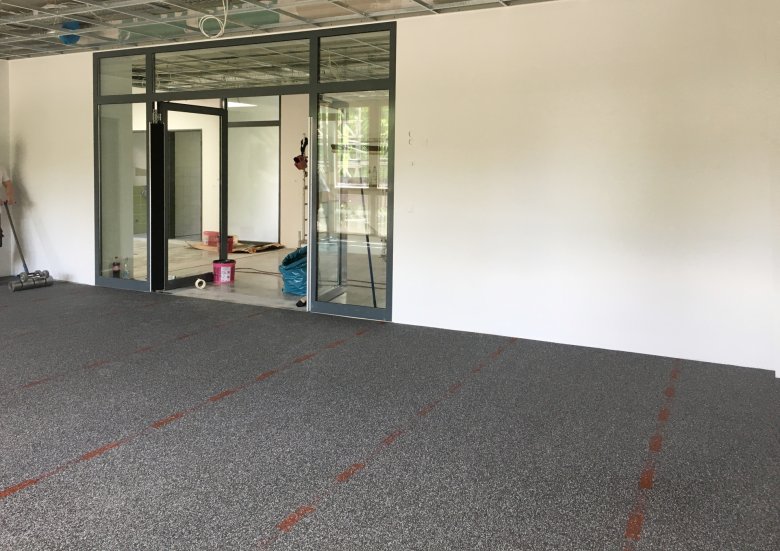

    The impact protection in the multi-purpose room was installed.

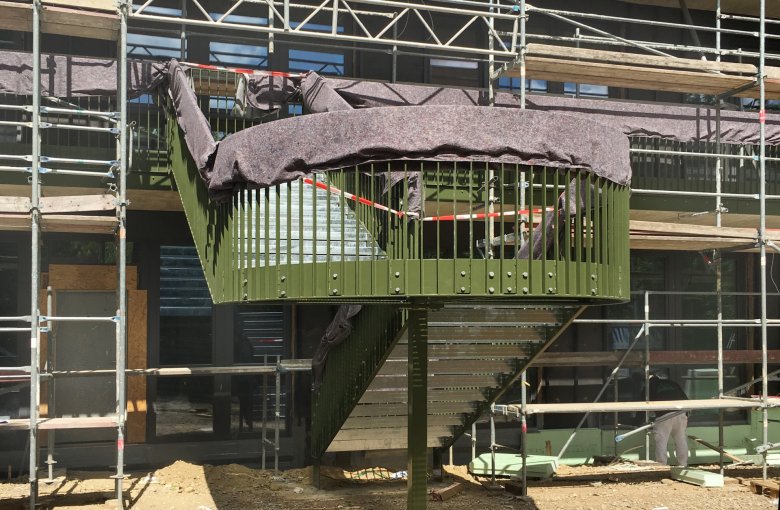

    The steel staircase has been delivered and installed.
    The steel staircase has been delivered and installed.

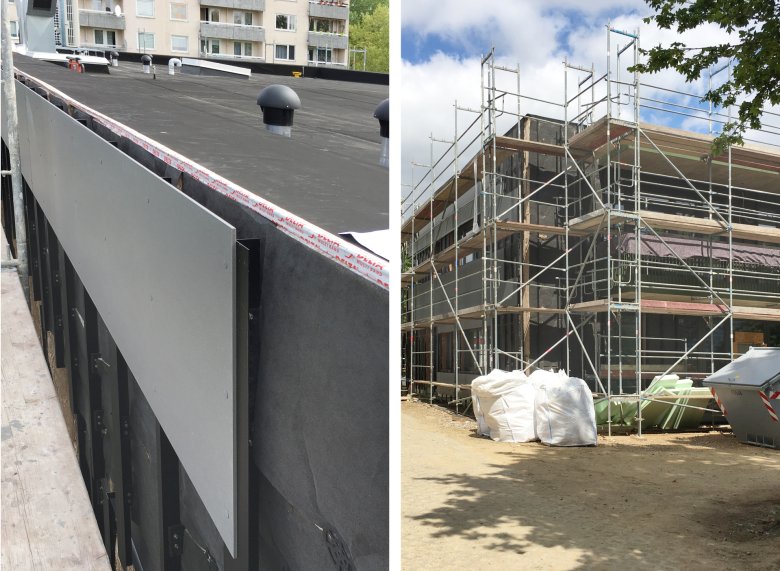

    The installation of the façade has begun.
    The installation of the façade has begun.

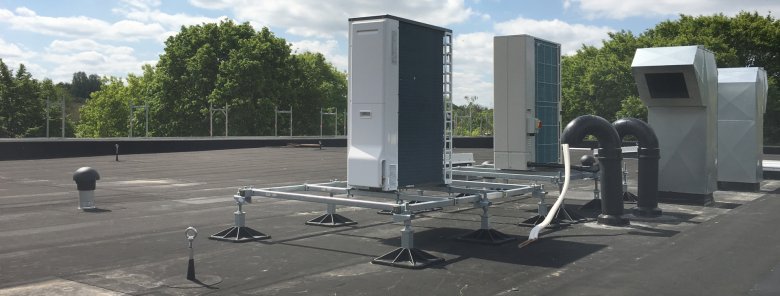

    The exhaust and supply air ducts on the roof were installed.
    The exhaust and supply air ducts on the roof were installed.
  • April 2020

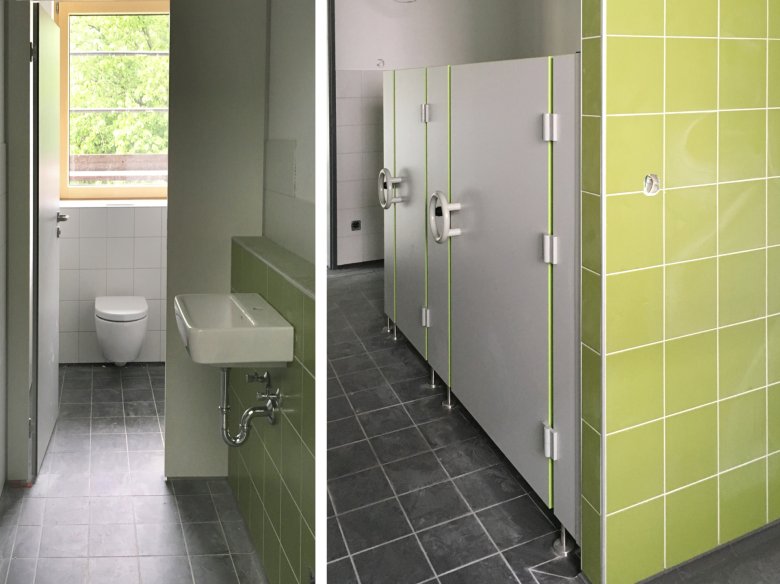

    The toilet partitions have been delivered and installed.
    The toilet partitions have been delivered and installed.

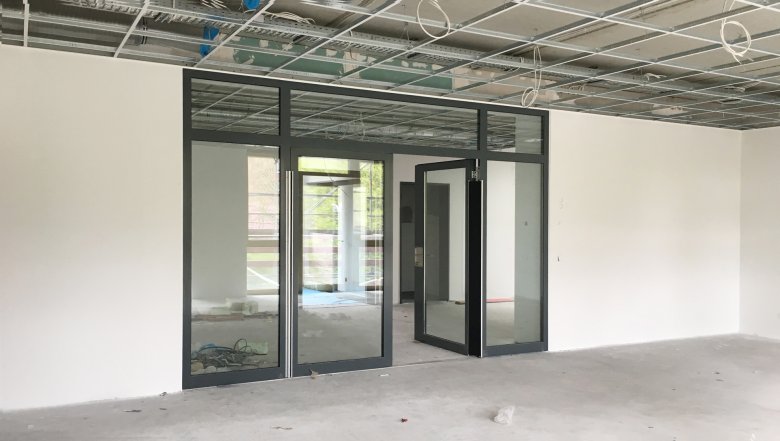

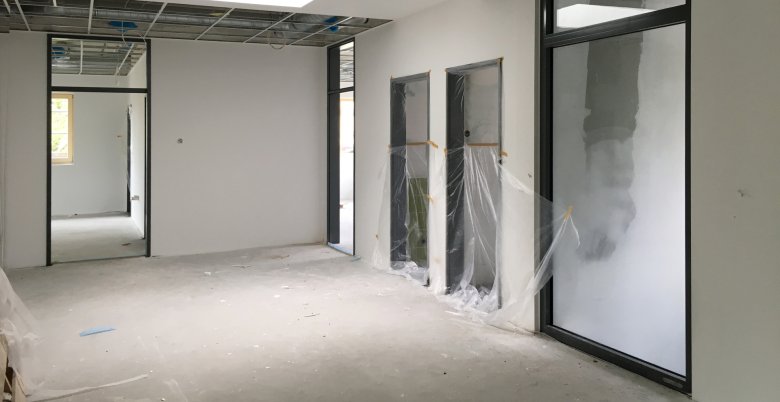

    The painting work is progressing.
    The painting work is progressing.
    The glass panes have been delivered and installed.
    The glass panes have been delivered and installed.
    Fassade_Demmung_fortgeschritten_c_E26_2020_04

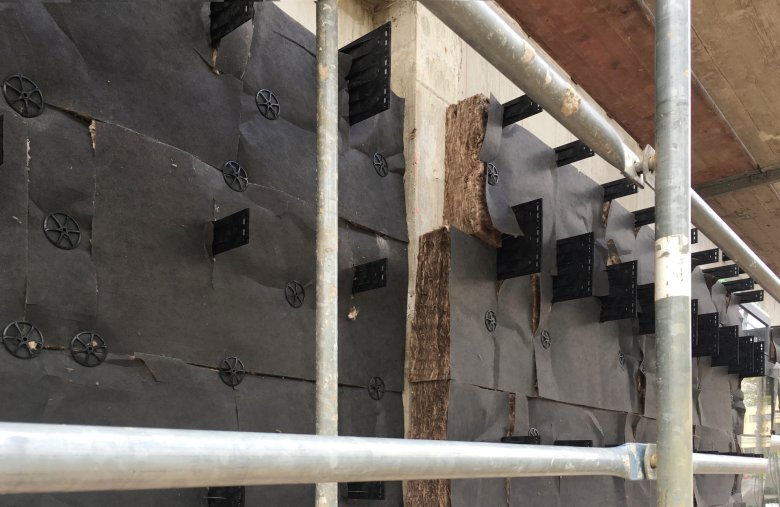

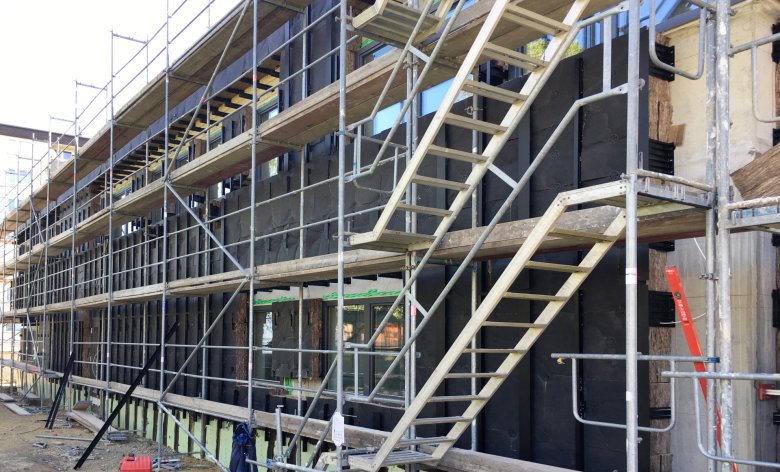

    The façade work is progressing. The thermal insulation for the façade has been delivered and installed.
    The façade work is progressing. The thermal insulation for the façade has been delivered and installed.

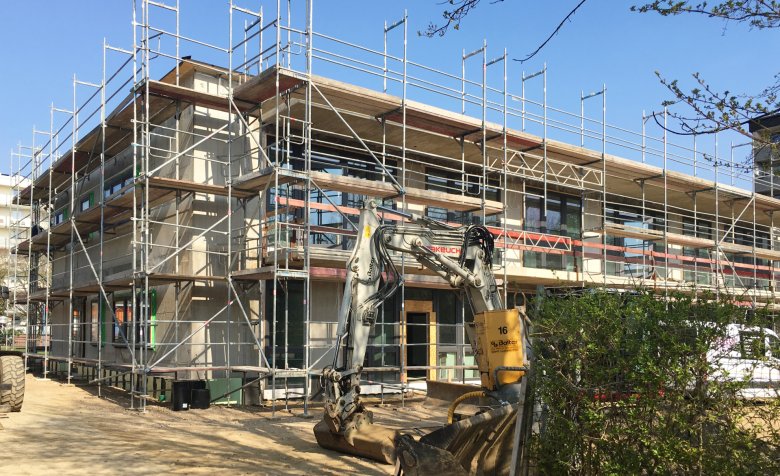

    The scaffolding has been erected along the façade. Work on the façade substructure has begun.
    The scaffolding has been erected along the façade. Work on the façade substructure has begun.
  • March 2020

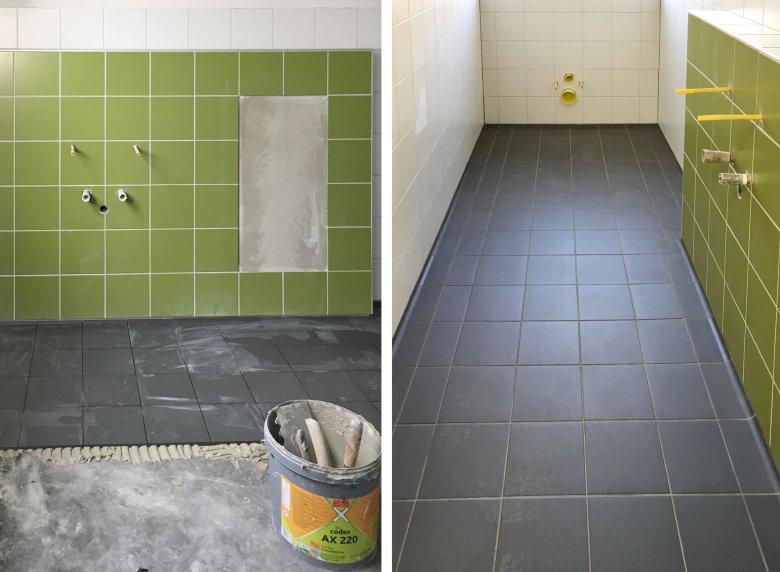

    The tiling work is progressing.
    The tiling work is progressing.

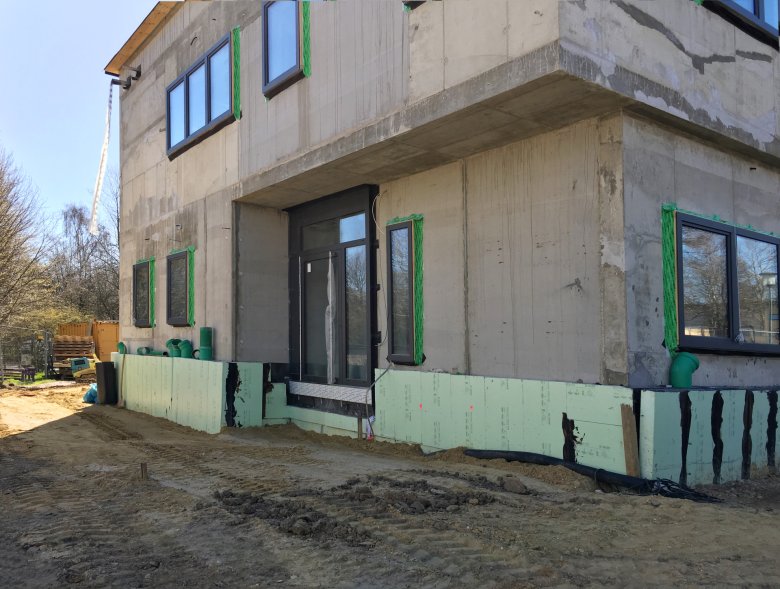

    The sewer work around the building has been completed.
    The sewer work around the building has been completed.
    The execution of the TGA medium has already been partially completed.
    The execution of the TGA medium has already been partially completed.
    The connection work for the TGA media is progressing.
    The connection work for the TGA media is progressing.
  • February 2020

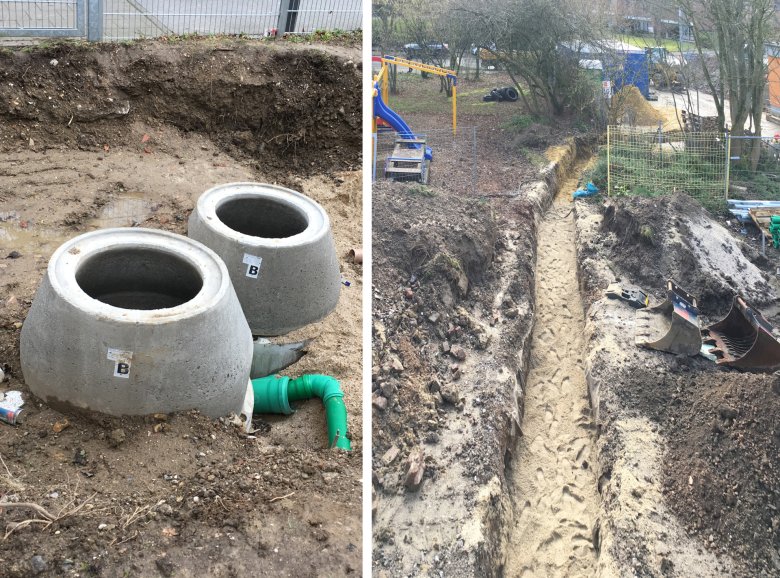

    Canal work
    Canal work

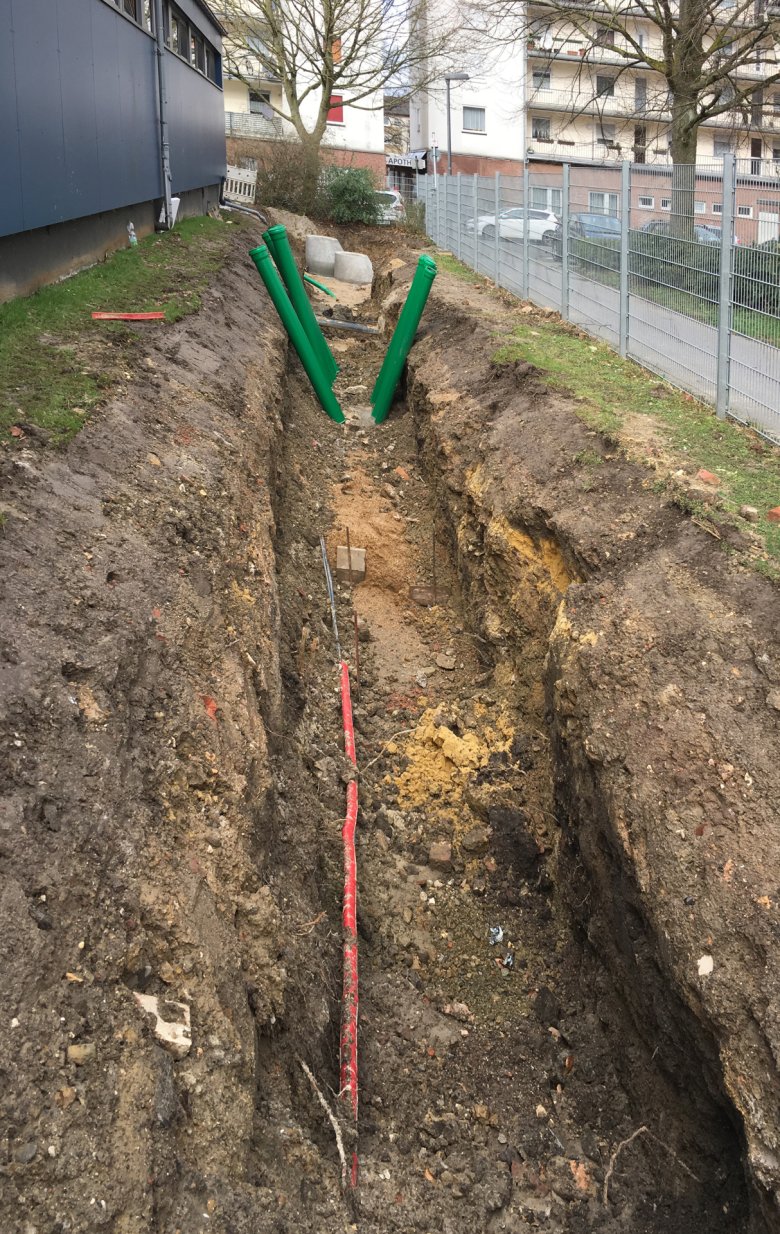

    The development of TGA media is progressing.
    The development of TGA media is progressing.
  • January 2020

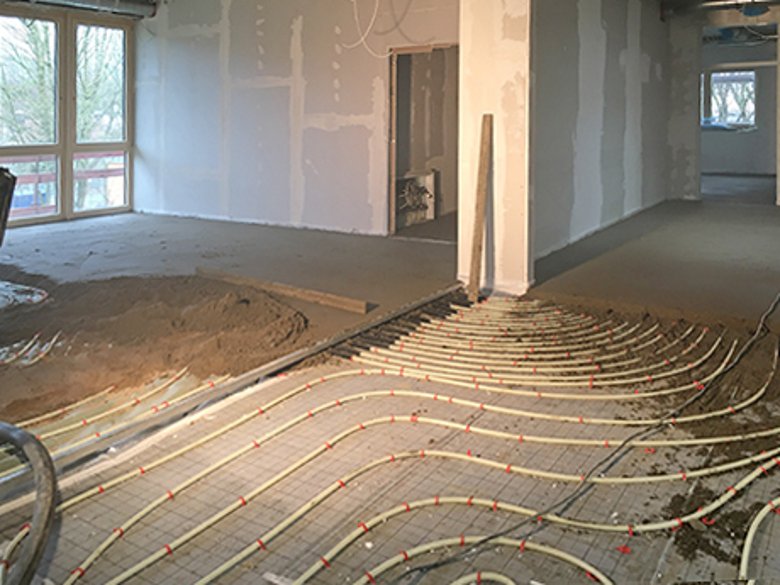

    The screed work on the upper floor has begun.

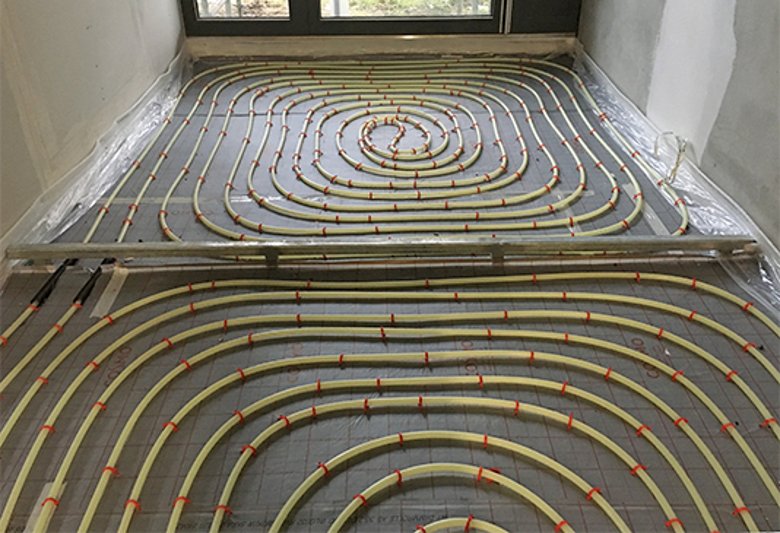

    The screed work on the upper floor has begun.

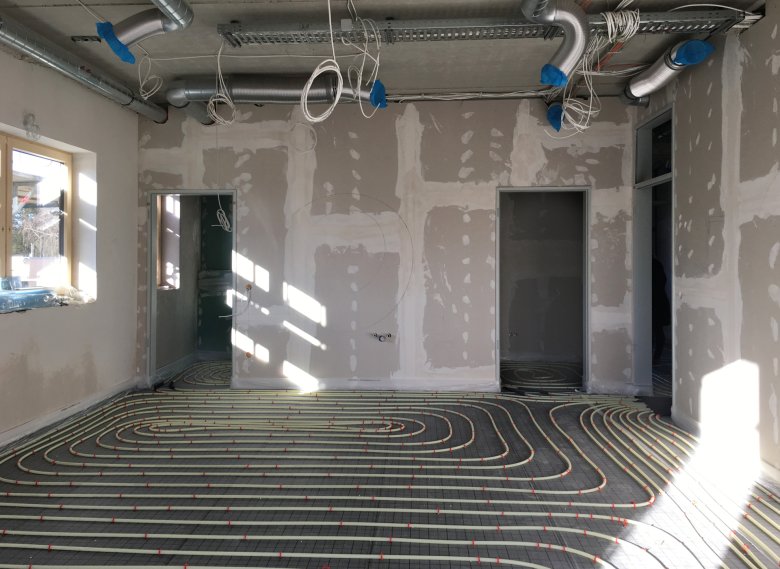

    Underfloor heating design
    Underfloor heating design
    The underfloor heating on the ground floor has been completed.
    The underfloor heating on the ground floor has been completed.

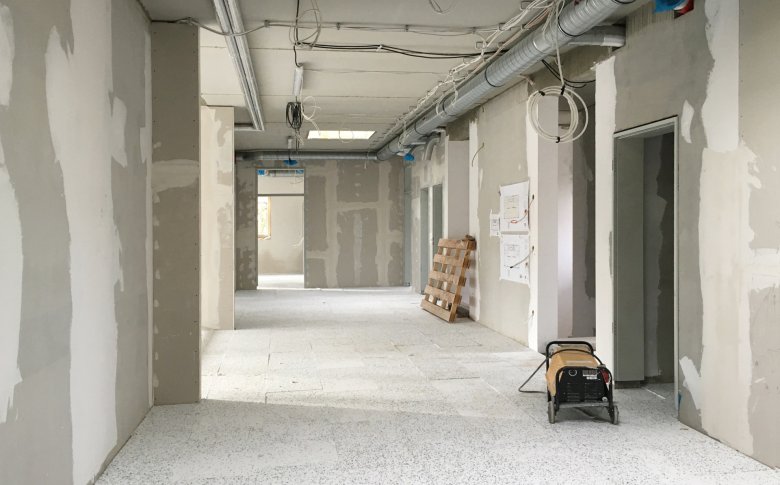

    The impact sound insulation on the upper floor has been installed.
    The impact sound insulation on the upper floor has been installed.

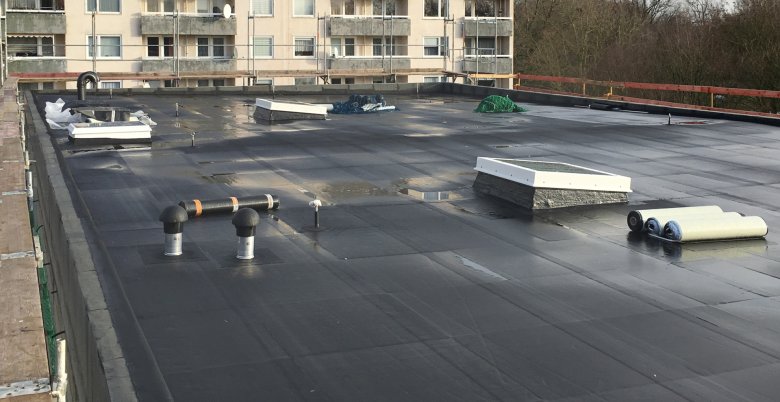

    The roof has been insulated.
    The roof has been insulated.
  • December 2019

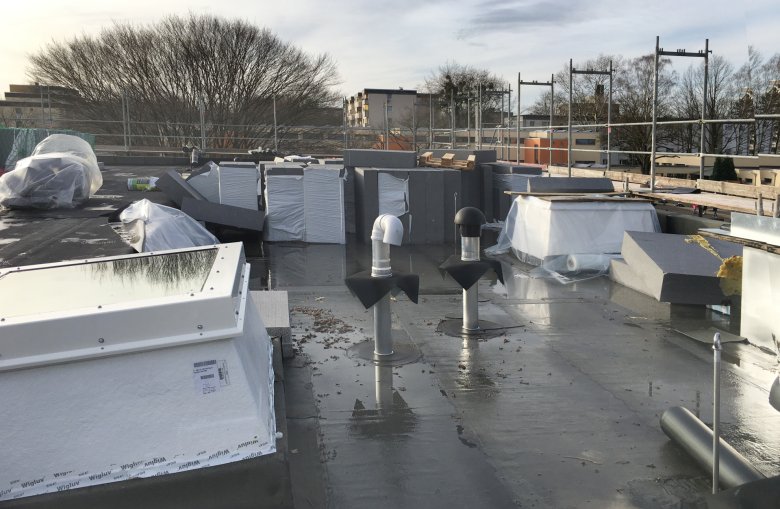

    The roof work is progressing.
    The roof work is progressing.
    The roof work is progressing.
    The roof work is progressing.

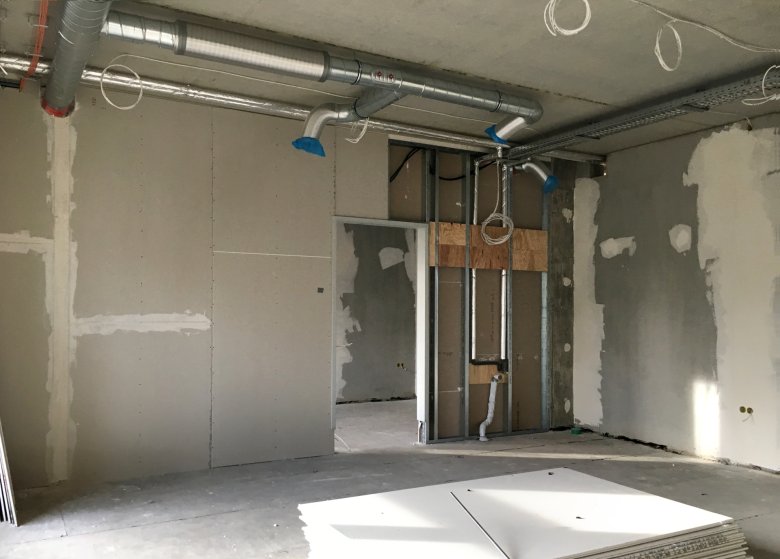

    TGA pipes
    TGA pipes
    The TGA work is progressing.
    The TGA work is progressing.
  • November 2019

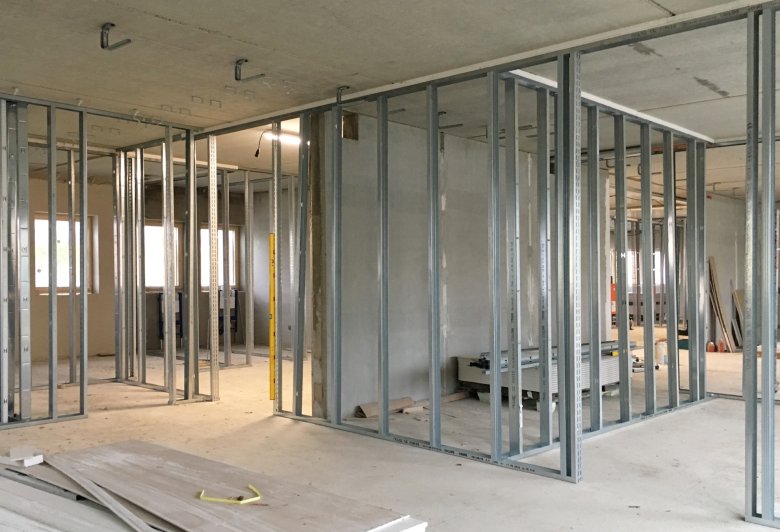

    Trockenbau_c_E26_2019_11

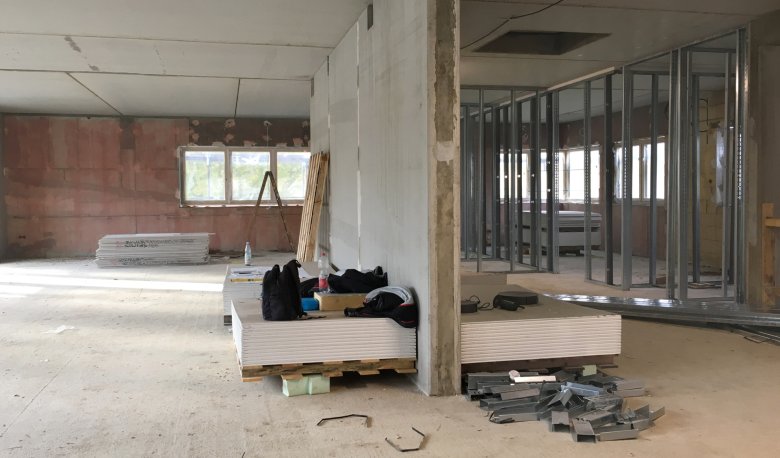

    The interior plastering and drywall work has begun.
    The interior plastering and drywall work has begun.
  • October 2019

    Fenster_Innenanicht_OG_c_E26_2019_10
    Fenster_Frontal_c_E26_2019_10

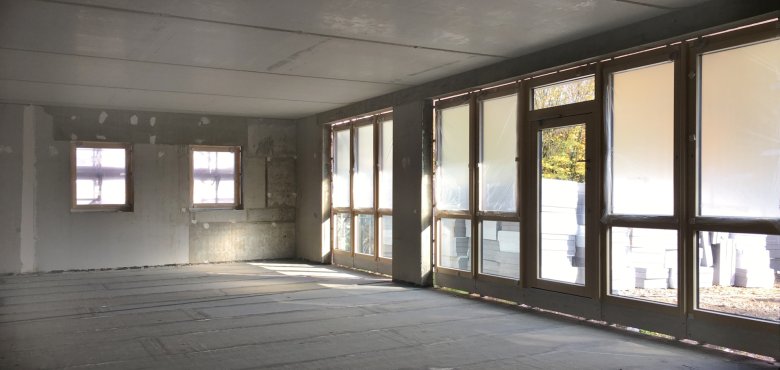

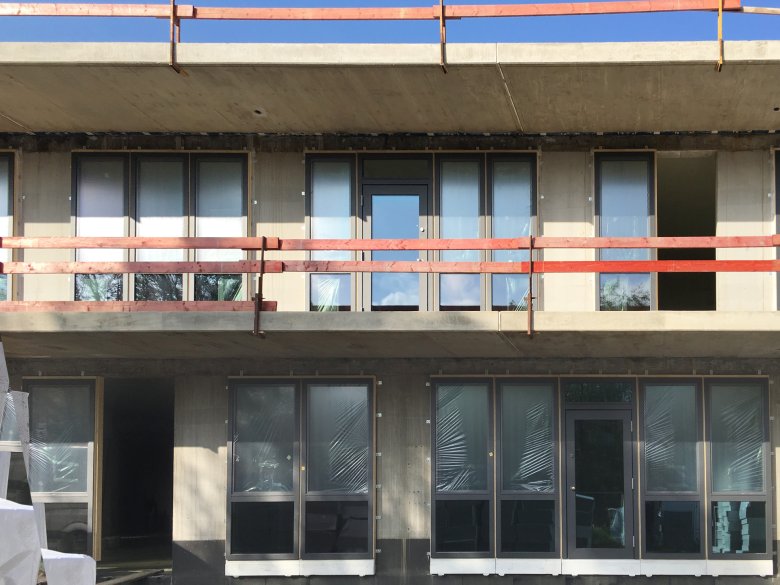

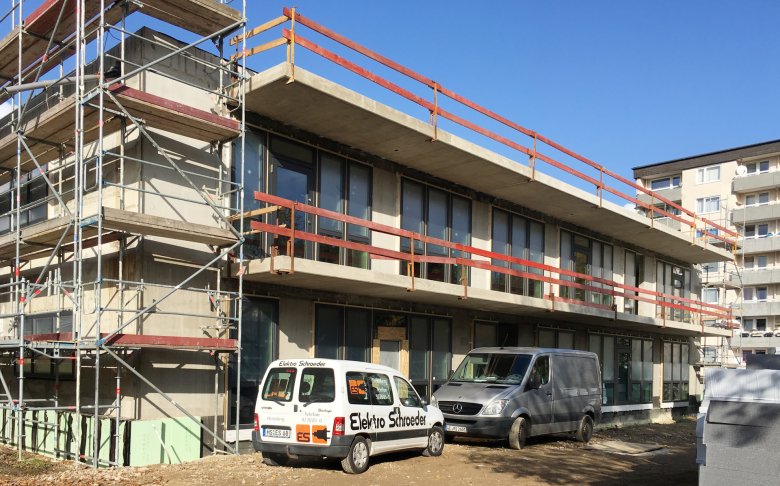

    The windows have been delivered and installed.
    The windows have been delivered and installed.
    Fertig_Rohbau_c_E26_2019_10

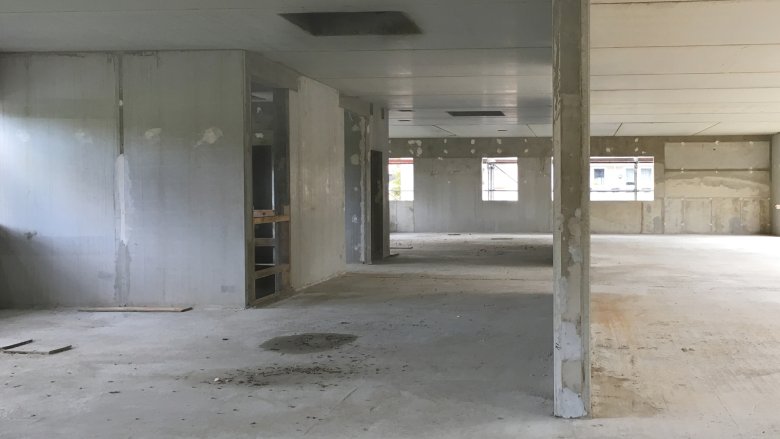

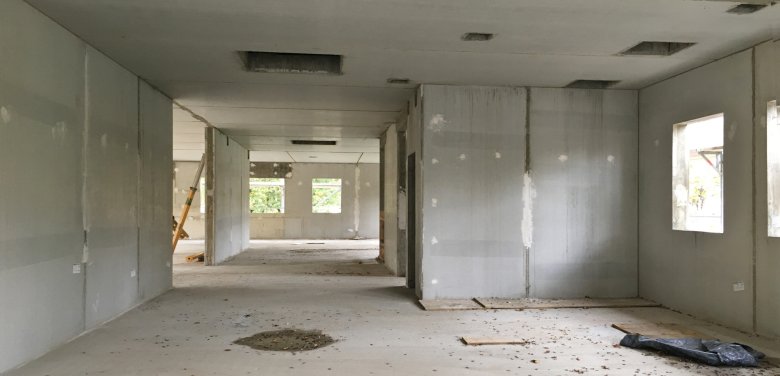

    The shell has been completed.
    The shell has been completed.

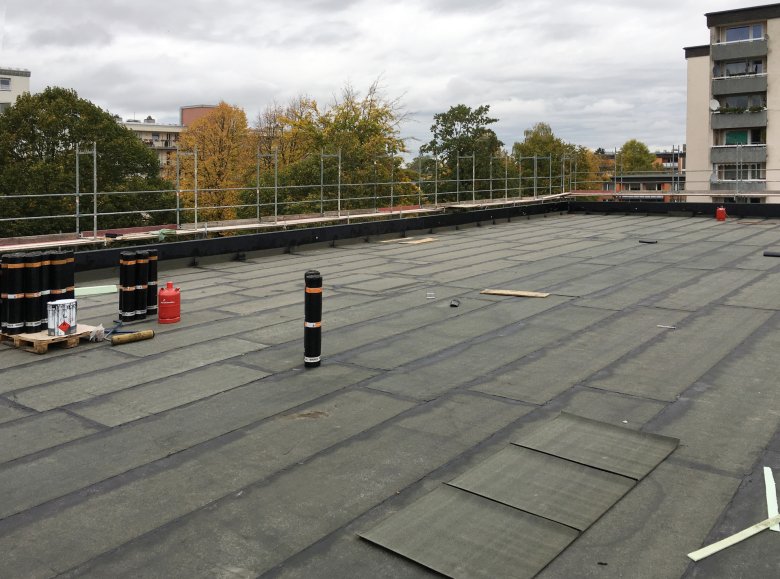

    Roofing work
    Roofing work
  • September 2019

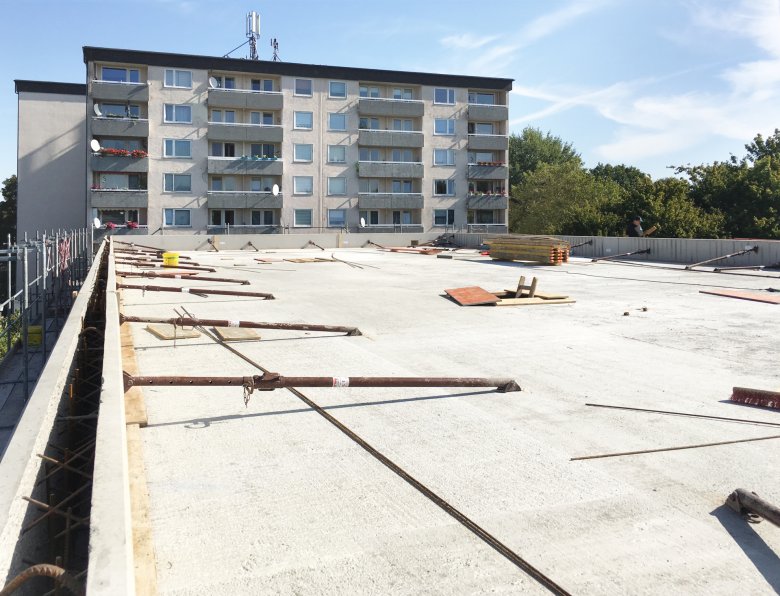

    The top floor has been concreted.
    The top floor has been concreted.

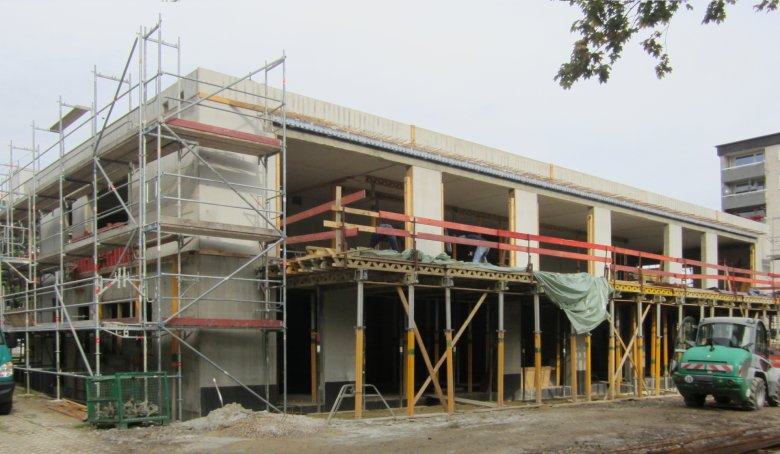

    The balcony is partially concreted. You can see the balcony with the scaffolding.
    The balcony is partially concreted. You can see the balcony with the scaffolding.

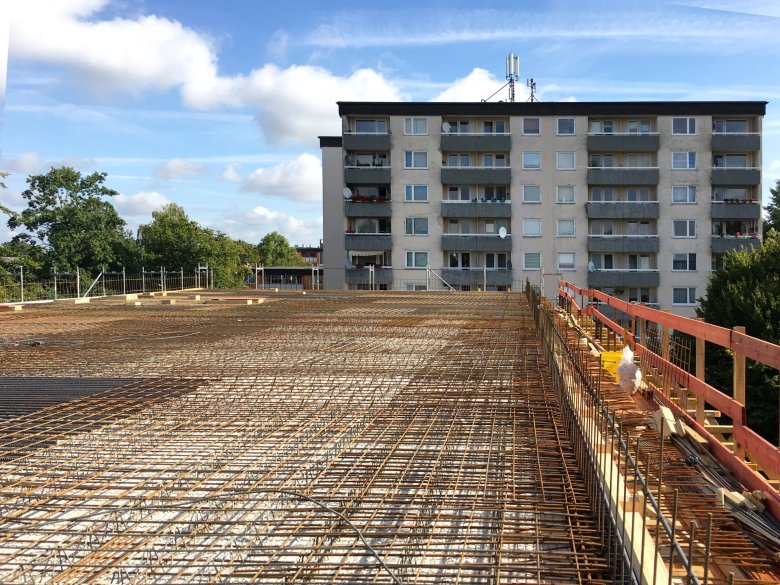

    Reinforcement roof above ground floor
    Reinforcement roof above ground floor

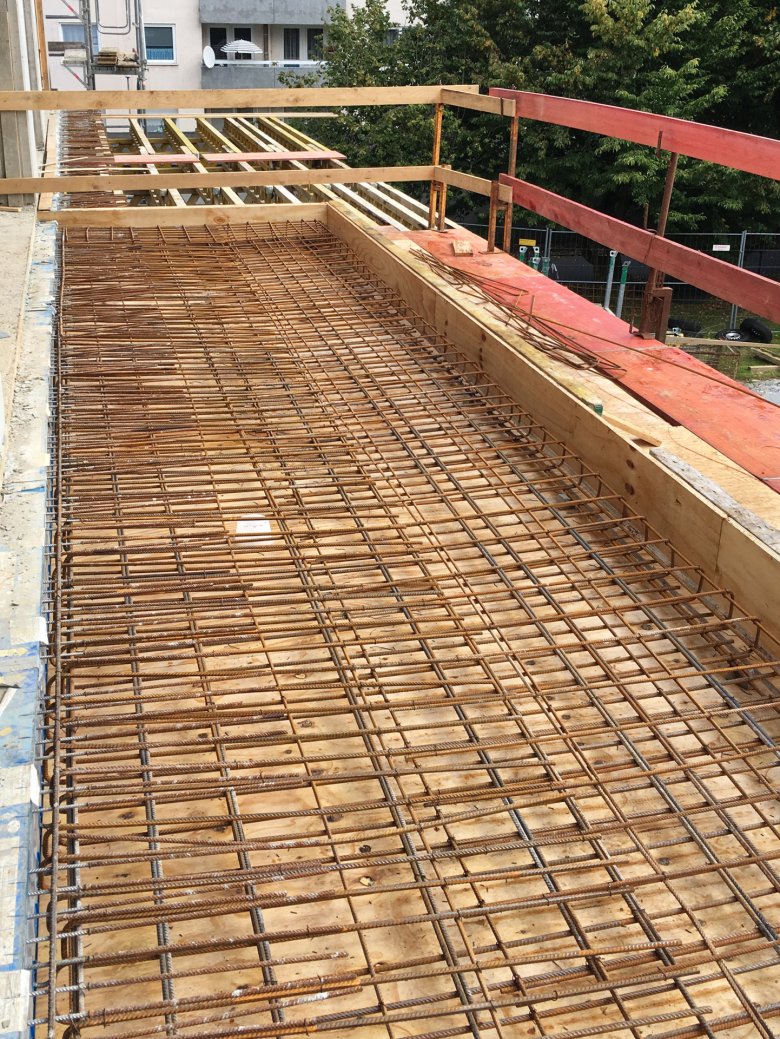

    The reinforcement of the balcony is carried out.
    The reinforcement of the balcony is carried out.

  • August 2019

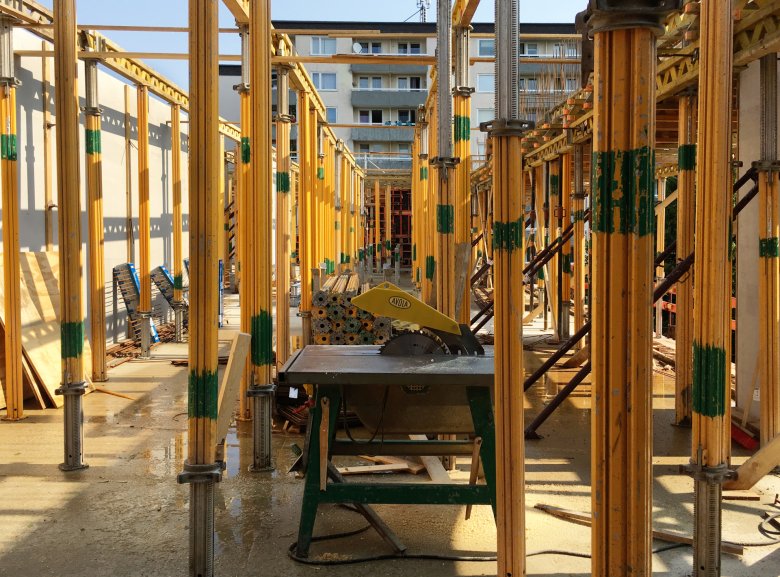

    The filigree walls on the upper floor have been delivered and erected.

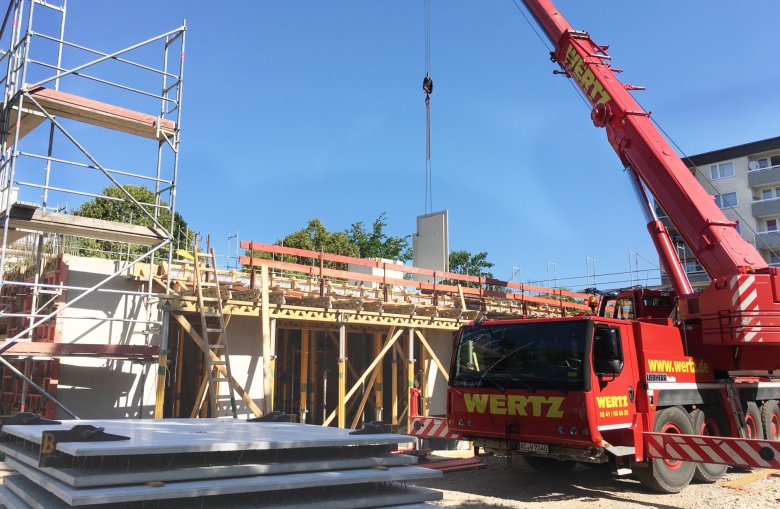

    The filigree walls on the upper floor have been delivered and erected.
    The supports for holding the filigree ceilings above the upper floor have been prepared.
    The supports for holding the filigree ceilings above the upper floor have been prepared.

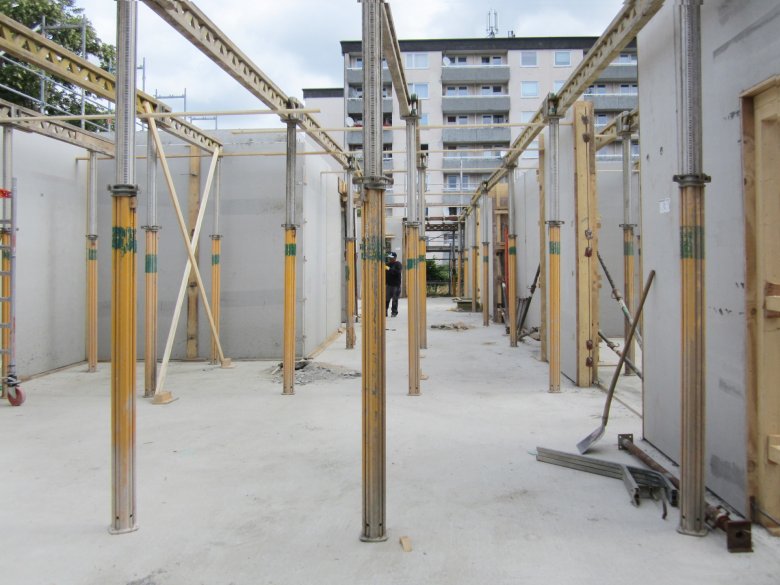

  • July 2019

    The ceiling above the ground floor has been concreted.
    The ceiling above the ground floor has been concreted.

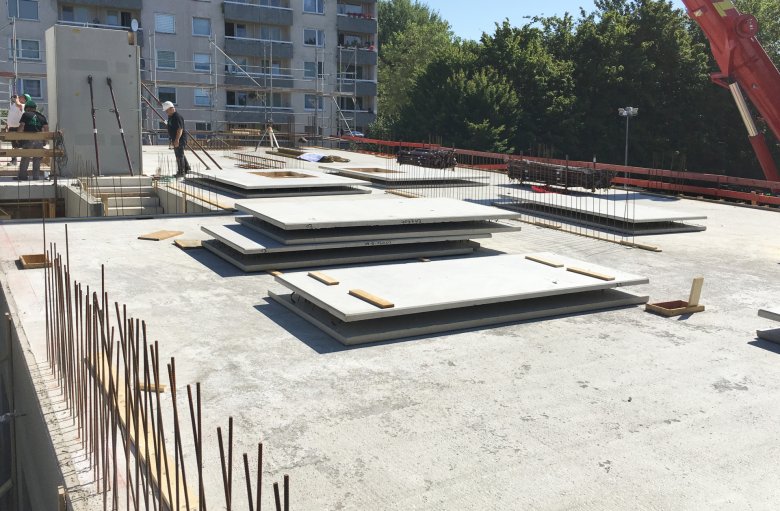

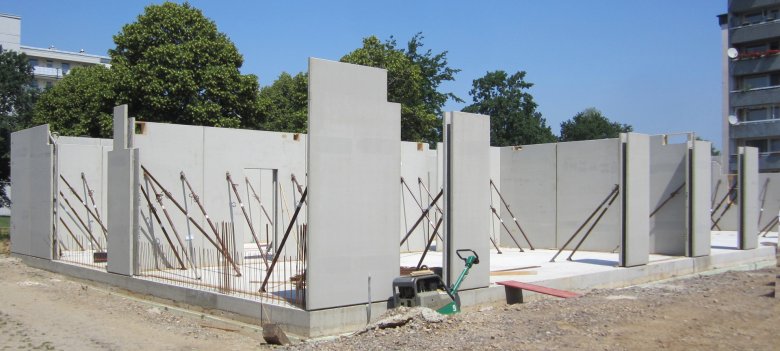

    The filigree walls for the upper floor have been delivered and are being installed.
    The filigree walls for the upper floor have been delivered and are being installed.

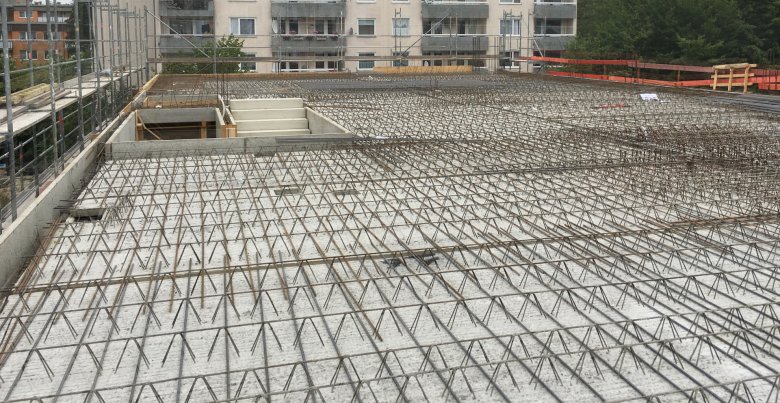

    Reinforcement OG
    Reinforcement OG
    The reinforced concrete staircase on the ground floor has been delivered and installed.
    The reinforced concrete staircase on the ground floor has been delivered and installed.

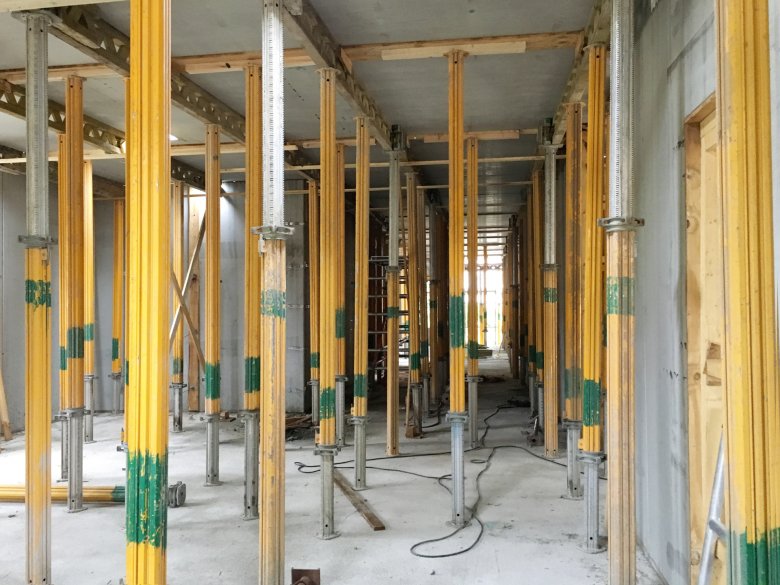

    The filigree ceiling above the ground floor has been delivered and installed.
    The filigree ceiling above the ground floor has been delivered and installed.
    The scaffolding for the prefabricated ceilings above the ground floor has been erected. The cast-in-place concrete walls on the ground floor are set in concrete.
    The scaffolding for the prefabricated ceilings above the ground floor has been erected. The cast-in-place concrete walls on the ground floor are set in concrete.
  • June 2019

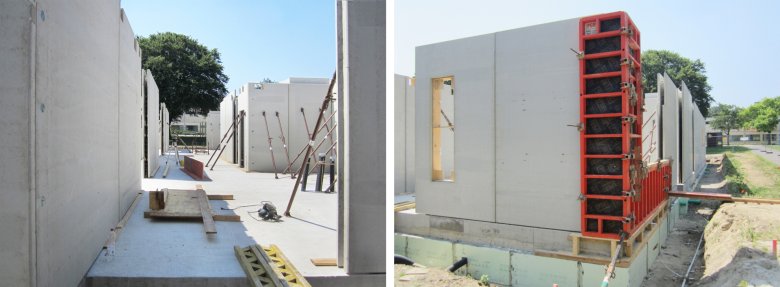

    Filigranwände_Erdgeschoss_c_E26_2019_06
    The floor slab has been set in concrete. The perimeter insulation has been installed. The filigree walls for the first floor have been delivered and installed.
    The floor slab has been set in concrete. The perimeter insulation has been installed. The filigree walls for the first floor have been delivered and installed.

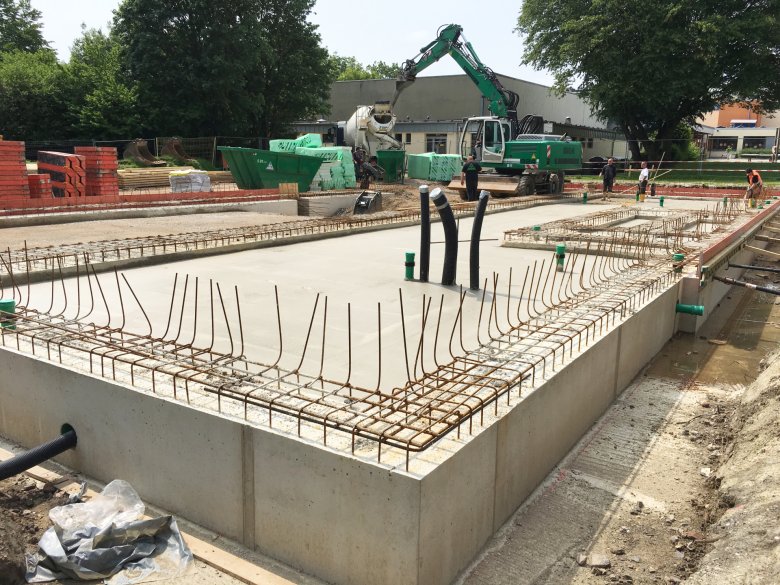

    The cleanliness layer is completed.
    The cleanliness layer is completed.
  • May 2019

    The ventilation for the strip foundations is delivered. The ground seals are installed and the strip foundations are marked. The strip foundations are shuttered and concreted. Work on the strip foundations is progressing. The strip foundations have been partially shuttered.
    The ventilation for the strip foundations is delivered. The ground seals are installed and the strip foundations are marked. The strip foundations are shuttered and concreted. Work on the strip foundations is progressing. The strip foundations have been partially shuttered.

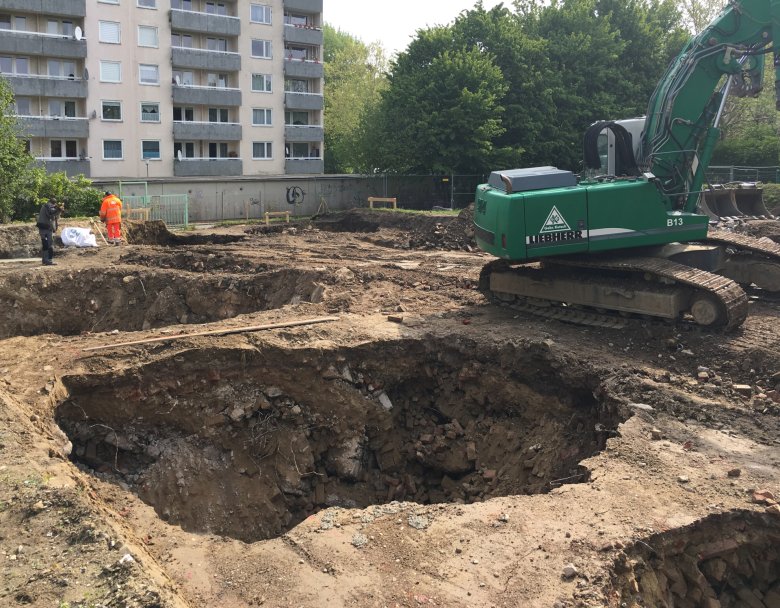

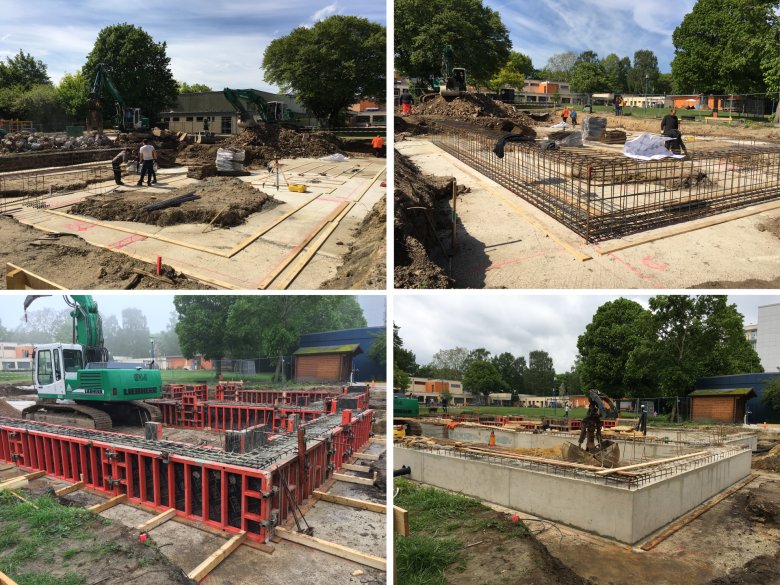

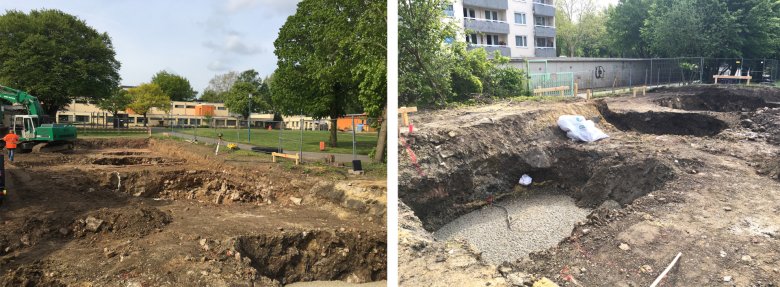

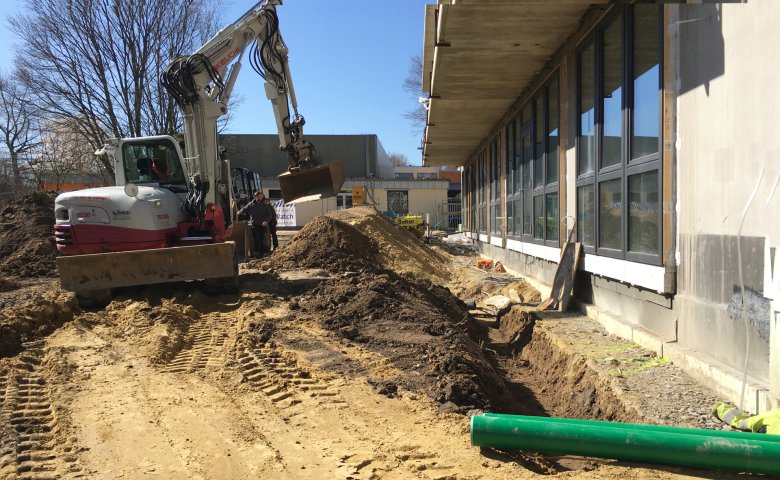

    The earthworks for the foundation are progressing.
    The earthworks for the foundation are progressing.
    The earthworks for the foundation are progressing.
  • April 2019

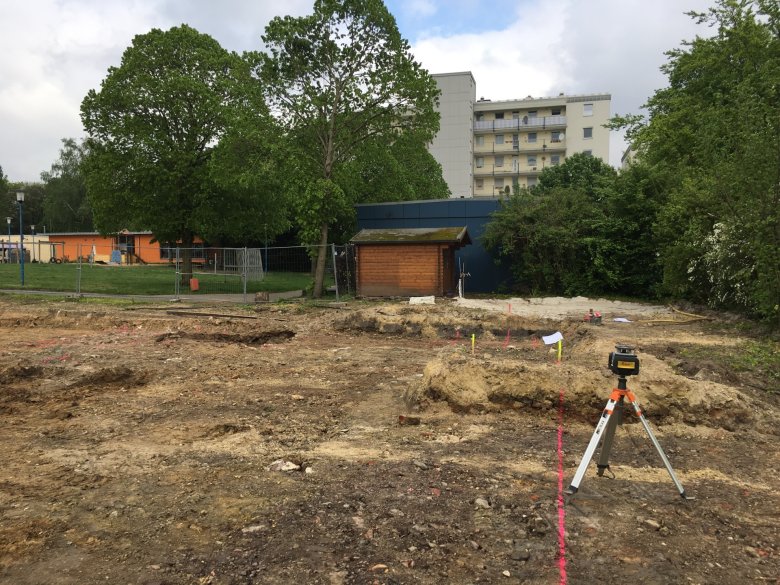

    The earthworks have begun. The surveyors have completed the rough staking out.
    The earthworks have begun. The surveyors have completed the rough staking out.
    Many concrete foundations have been found in the ground.
    Many concrete foundations have been found in the ground.
  • December 2018 Demolition work

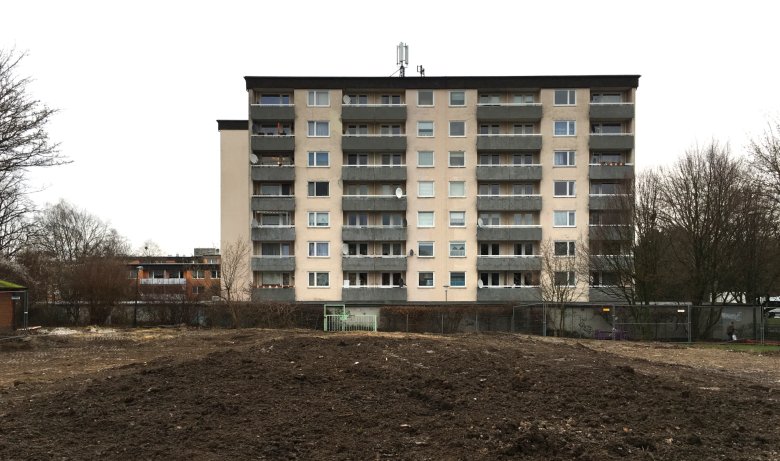

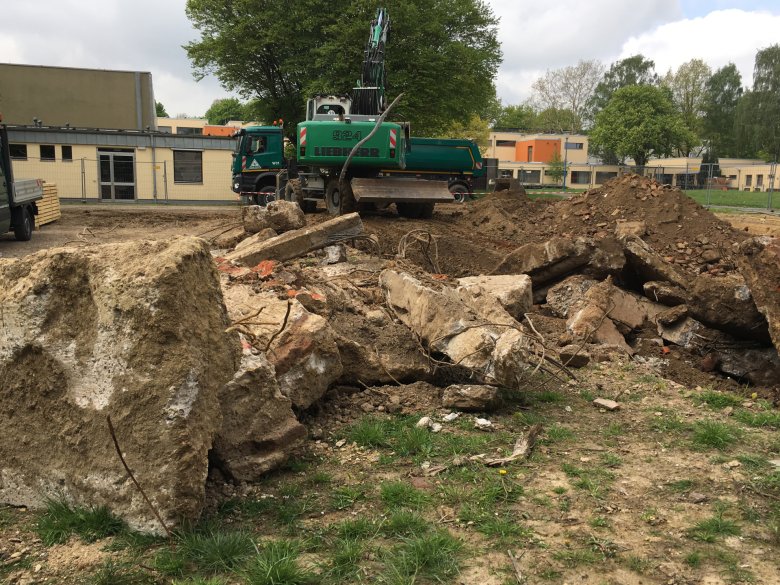

    The demolition work has been completed.
    The demolition work has been completed.

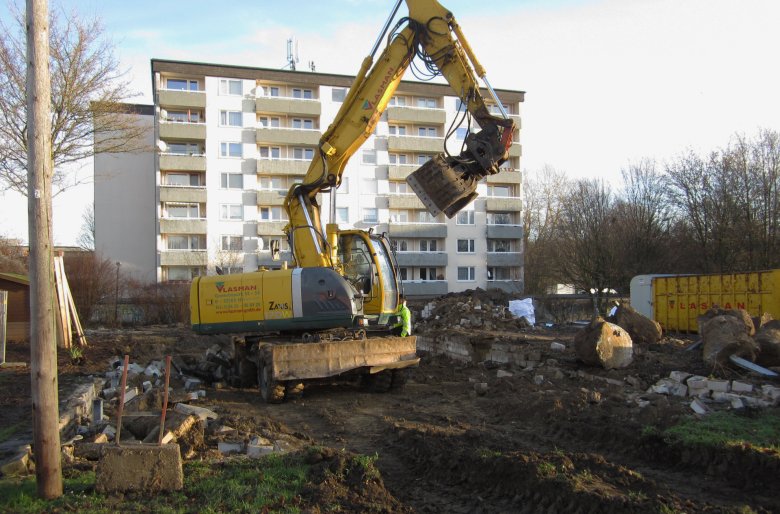

    The demolition work is progressing.
    The demolition work is progressing

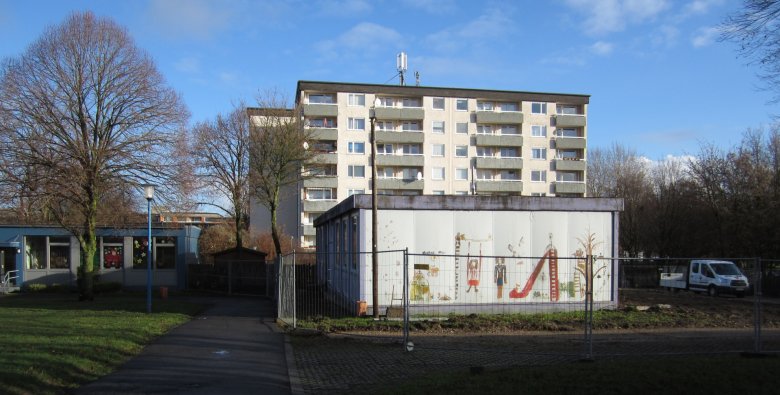

    Set-up of the construction site and start of dismantling
    The upper floor was completed.
    Construction site equipment
    Construction site equipment

Concept

The new building will be erected in the same place as the pavilion and forms the southern boundary of the schoolyard. The group rooms face the outdoor play area, while functional and staff rooms face the schoolyard. A wide central play corridor connects the rooms and creates additional play areas. In addition, a separate staircase with an escape balcony provides access and safety.

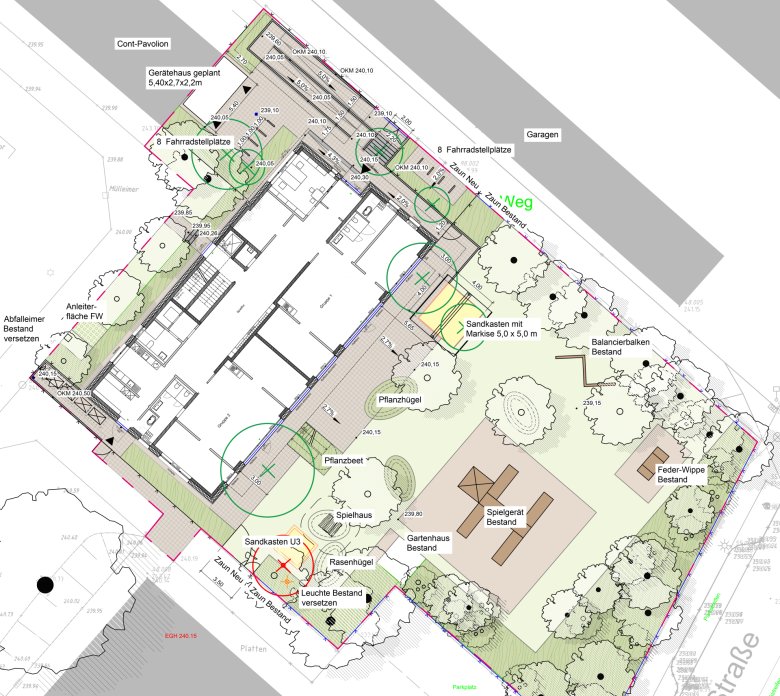

Open space planning
Open space planning

Energy concept

The energy concept of the new building is based on a combination of modern technologies to ensure an efficient and sustainable energy supply. A comprehensive ventilation system with heat recovery ensures a healthy indoor climate with low energy consumption. This is complemented by an air/water heat pump with underfloor heating, which enables efficient heating. In addition, a photovoltaic system on the roof contributes to environmentally friendly electricity generation and thus supports the daycare center's energy requirements.

Further project information

  • Room program

    There are a total of 4 groups with the following group forms:

    • Group form II (0-3 years): 2 groups on the ground floor
    • Group form III (3-6 years): 2 groups on the upper floor

    In accordance with DVO KiBiz, 160m² for an Ü3 group and 185m² for an U3 group are recognized for refinancing the rent. This results in a maximum total usable area of 690 m² for the planned group types.
    The compact design makes it possible to implement a therapy room in addition to the room program specified by the LVR.

  • Views and sections

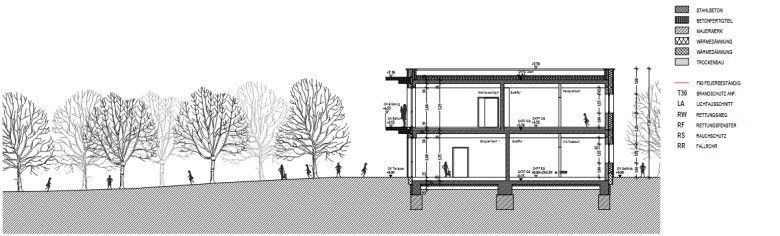

    Longitudinal section Section A-A
    Longitudinal section Section A-A

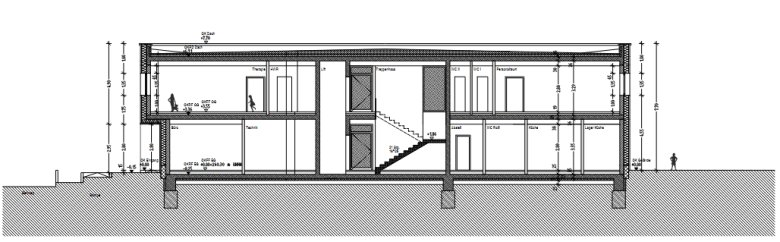

    Cross-section Section B-B
    Cross-section Section B-B

    View north-west
    View north-west

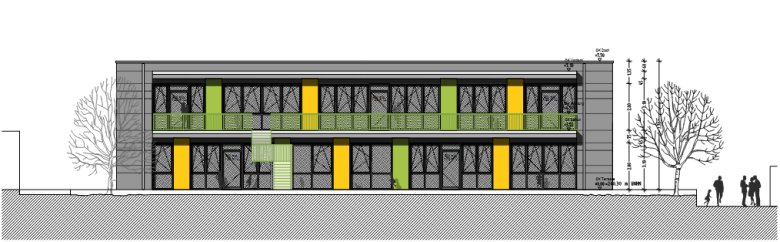

    View south-east
    View south-east

    View south-west
    View south-west
    View north-east

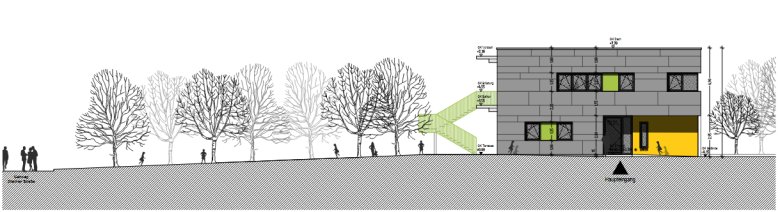

    View north-east
  • Model photos

    Model photo2

    Model photo1

  • As-built photo of demolished pavilion

    Stock photo
    Stock photo

Help with accessibility

  • General

    We make every effort to ensure that our websites are accessible. You can find details on this in our accessibility statement. You can send us suggestions for improvement using our"Report a barrier" feedback form.

  • Font size

    To adjust the font size, please use the following key combinations:

    Larger

    Ctrl
    +

    Smaller

    Ctrl
  • Keyboard navigation

    Use TAB and SHIFT + TAB to navigate through next/previous links, form elements and buttons.

    Use ENTER to open links and interact with elements.
