New construction KGS Bildchen 2023

Single-track elementary school with forum for school and external use


This project has been completed.
KGS picture


Occasion and goal

The existing school building was in a very poor structural condition and could no longer be renovated with reasonable effort. This was taken as an opportunity to plan a future-oriented building with an upstream user participation in a workshop and subsequent architectural competition.

  • Key data

    • Good school 2020 - investment program: replacement new building KGS Bildchen, OGS with canteen, central hub as assembly room, also for the district
    • Net room area NRF: 1,288 m²
    • Gross volume: 7,600 m³
    • Construction period: November 2020 to August 2023
    • Passive house standard
    • District heating and ventilation system with heat recovery
    • Architects: NEW Architekten, winner of the architectural competition
  • Completion photos Andreas Horsky 2023

    Forum
    Forum
    Forum
    Forum
    Schoolyard
    Schoolyard
    Schoolyard
    Schoolyard
    Classroom
    Classroom
    Classroom
    Classroom
    Facade
    Facade
    View
    View
    View
    View
    Forum
    Forum
    Interior views
    Interior views
    Forum
    Forum
    Forum
    Forum
    Interior views
    Interior views
    Interior views
    Interior views
    WC facilities
    WC facilities
    The multifunctional forum with seating
    The multifunctional forum with seating
    Inauguration of the new KGS Bildchen building
    Inauguration of the new KGS Bildchen building
    View
    View


Construction site photos

  • April 2023 Floor coverings

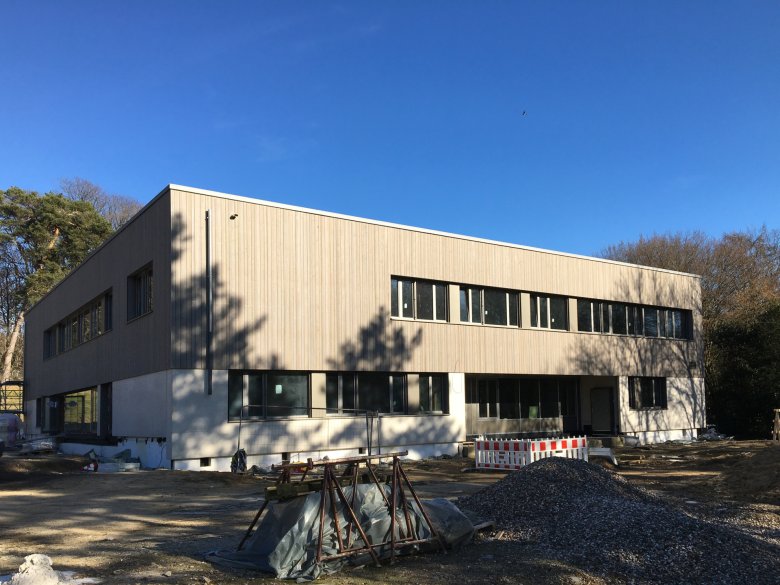

    The exterior view in April
    The exterior view in April
    Parquet and tiled floors are installed.
    Parquet and tiled floors are installed.
    The WCs are installed.
    The WCs are installed.


  • December 2022 Envelope and photovoltaic system

    The cover has been closed.
    The cover has been closed.
    Substrate for the greenery and the substructure for the PV system were installed on the roof.
    Substrate for the greenery and the substructure for the photovoltaic system were installed on the roof.
    The windows have been installed and the wall structure can be seen.
    The windows have been installed and the wall structure can be seen.
    The wooden façade on the upper floor
    The wooden façade
    Further installations in the interior are in progress.
    Further installations in the interior are in progress.
  • November 2022

    Interior work and rough installation are underway.
    Interior work and rough installation are underway.
    The screed has been laid and further installation work is starting.
    The screed was laid and further installations started.


  • October 2021 Foundation pipes and floor slab

    Ground pipes
    Ground pipes
    The frost aprons are being worked on and the concreting of the floor slab is being prepared.
    The frost aprons are being worked on and the concreting of the floor slab is being prepared.
  • September 2022 Facades

    The exposed precast concrete elements for the façade on the first floor have been delivered and are waiting to be installed.
    The exposed precast concrete elements for the façade on the first floor have been delivered and are waiting to be installed.
    The installed exposed concrete element with cavity insulation
    The installed exposed concrete element with cavity insulation
  • February 2022 Shell construction

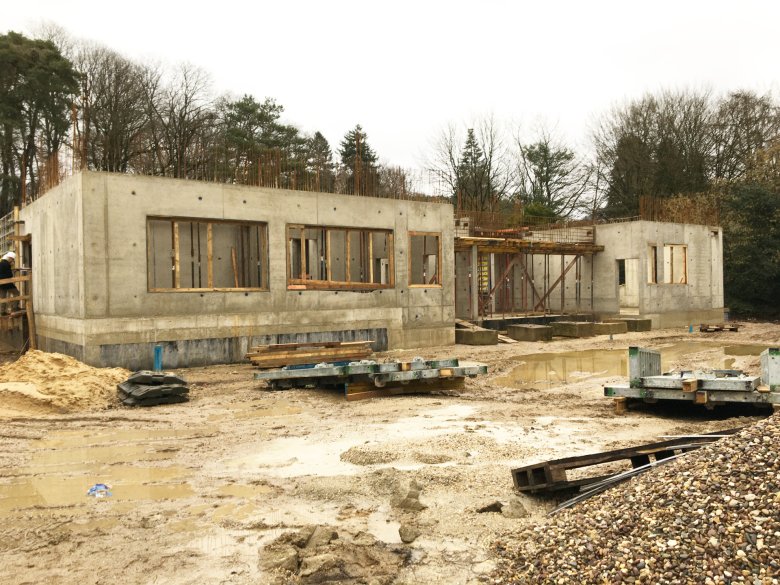

    The walls on the first floor are largely completed.
    The walls on the first floor are largely completed.

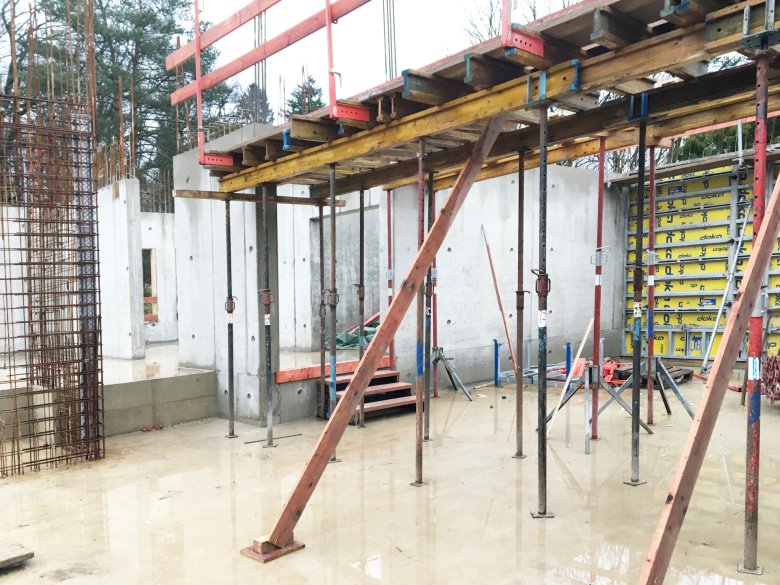

    Work began on forming the ceiling above the first floor.
    Work began on forming the ceiling above the first floor.

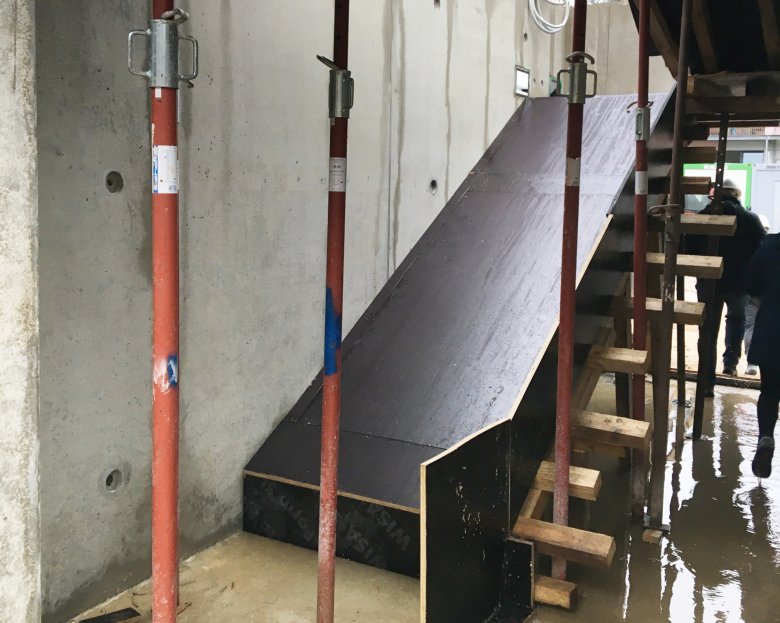

    Staircase formwork
    Staircase formwork
  • January 2022 Exposed concrete walls

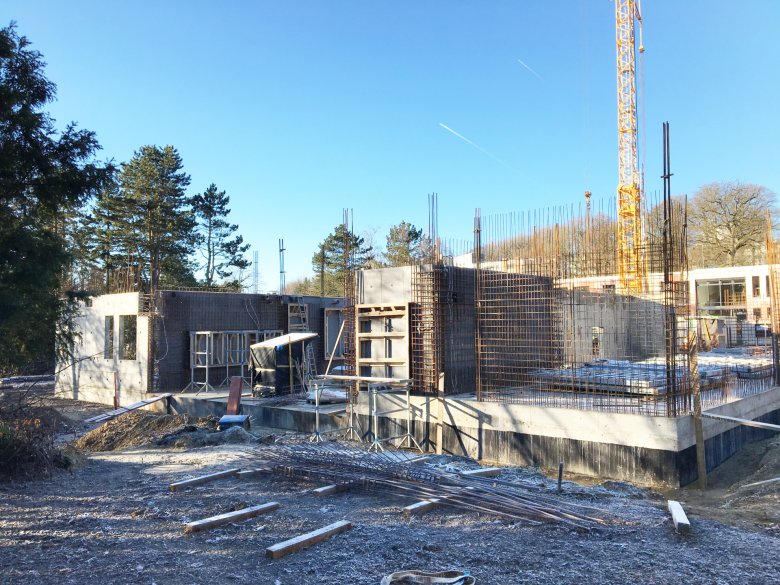

    The first floor is taking shape.
    The first floor is taking shape.
    Walls on the first floor
    Walls on the first floor
    The first walls in exposed concrete quality are formed.
    The first walls in exposed concrete quality are formed.

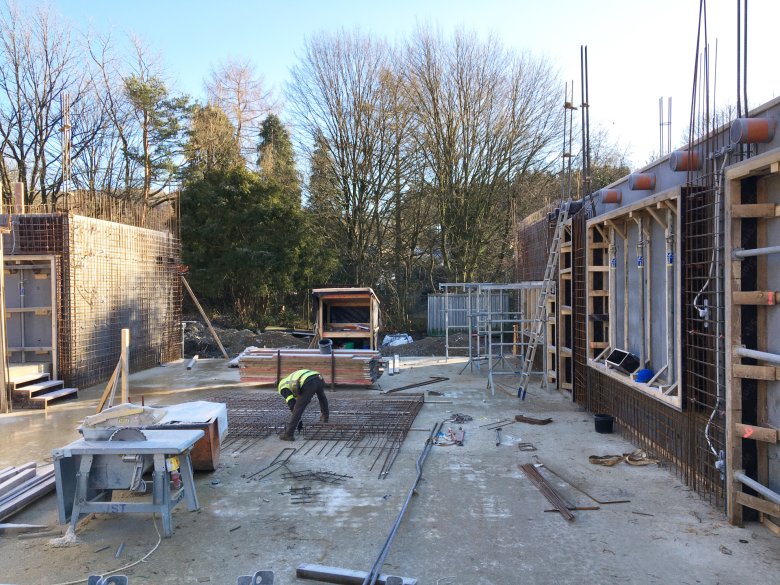

    Reinforcement work
    Reinforcement work
    Details of the preparation for an exposed concrete wall
    Details of the preparation for an exposed concrete wall
    The reinforcement for the walls on the first floor
    The reinforcement for the walls on the first floor
  • June 2021 Planum

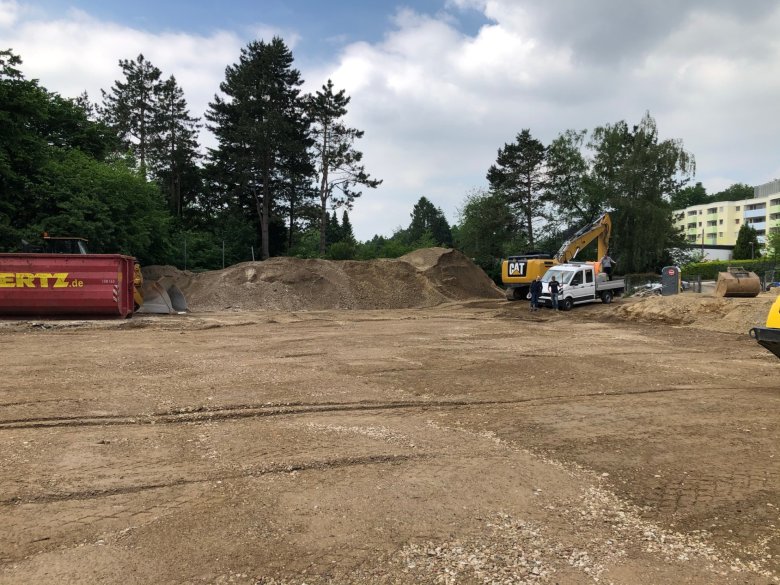

    Backfilling, excavation and the creation of the formation level have begun.
    Backfilling, excavation and the creation of the formation level have begun.
  • December 2020 Demolition and processing RCL

    The demolition material is recycled on site to be reused for the new building.
    The demolition material is recycled on site to be reused for the new building.
    Demolition began after the pollutant clean-up.
    Demolition began after the pollutant clean-up.
    Existing view of the old elementary school
    Existing view of the old elementary school

Multifunctional utilization concept

  • Four regular classes are complemented by a wide range of rooms for additional uses and opportunities for spatial differentiation and individualized teaching.
  • In addition to everyday school use, the forum, the central hall, can be used as a meeting place for school or external events for the district. The dining room can be added to the forum for this purpose if required.

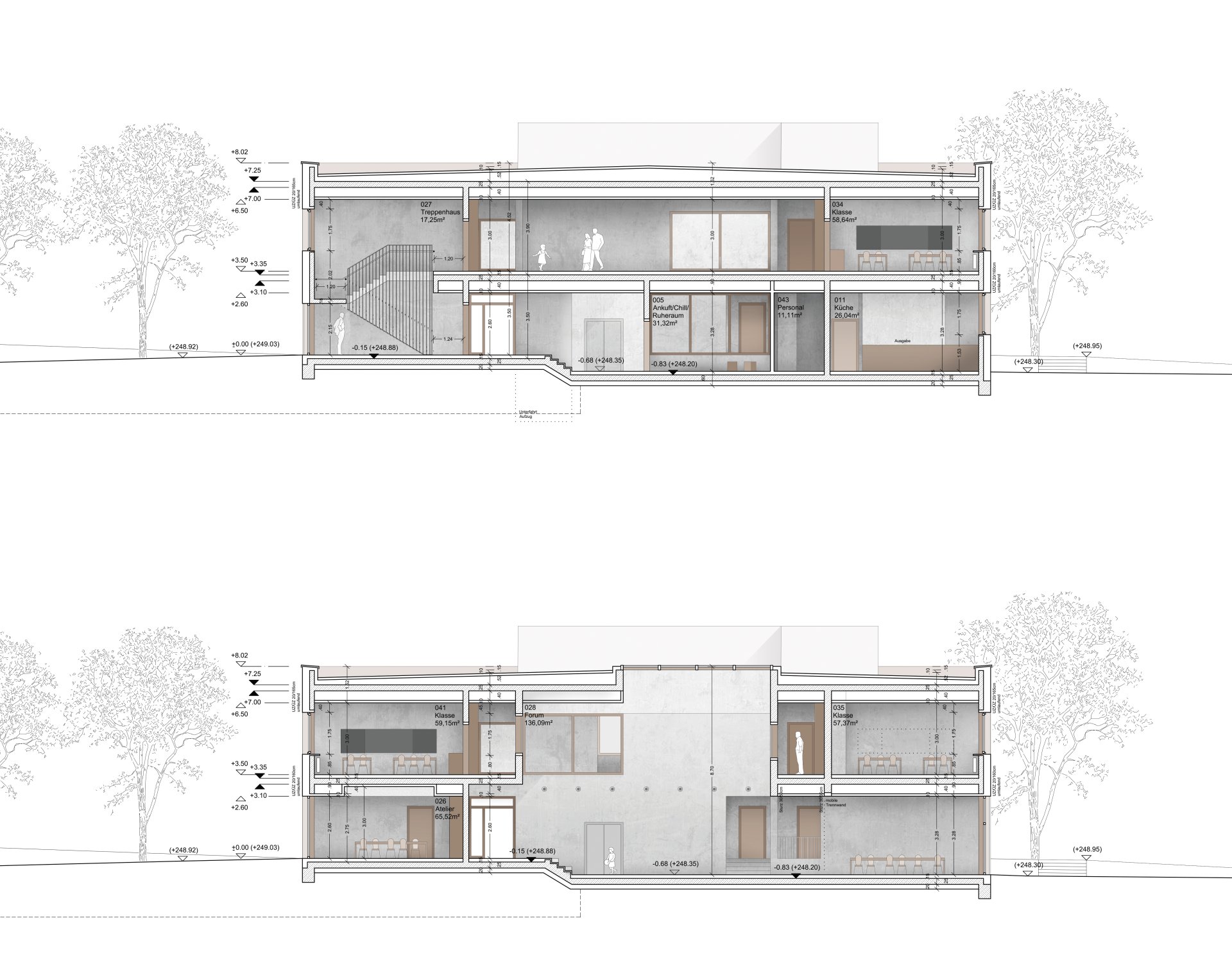

Cuts
Cuts



Sustainability

Recycled gravel (RCL)
Once the pollutant clean-up had been completed, the existing building was demolished and the demolition material was prepared on site as recycled material for the new building.

Other aspects of sustainability

  • District heating
  • Passive house standard
  • Avoidance of composite building materials
  • Based on Cradle to Cradle (c2c)
  • Ventilation system with heat recovery
  • Reuse of the old play equipment

Further project information

  • Architecture

    Together with the existing daycare center and sports hall buildings as well as the extensive outdoor facilities, the new building forms a common "educational landscape" around the central schoolyard. The spatial concept of the school is the arrangement of all rooms around a central two-storey space called the forum. The forum is a place for special events on the one hand, and a play, learning and communication space on the other. The exterior of the building has a clear cubature on a square footprint. Important interior spaces (entrance, studio, dining room) are emphasized by floor-to-ceiling openings, thereby strengthening the connection to the open spaces.

  • Construction

    The building is constructed as a structure of load-bearing wall panels made of reinforced concrete. The foundation is made of strip foundations. Ceilings and the roof are also planned in concrete.

    The roof was designed as a warm roof with a green roof structure. There is also a large-scale PV system and technical structures on the roof.

  • Materials

    The aim of the interior design is to create a pleasant and stimulating learning atmosphere. To this end, a reduced and homogeneous material canon is aimed for. Against the background of high durability, exposed concrete and wood are essential materials. The floors are planned as industrial parquet in special areas (first floor forum) and as linoleum in all other common areas. Grid ceilings with high sound absorption are planned for the ceilings.

  • Facade

    The façade is divided into first floor and upper floor. The ground floor is clad in robust prefabricated exposed concrete elements alternating with large floor-to-ceiling glass elements. The upper floor has a rear-ventilated timber façade.

  • Open space planning

    The open spaces are divided into zones for different uses at different levels.

    From the southern main entrance, pupils first reach the neighbourhood square; the teachers' parking lot (4 + 1 disabled parking spaces) is accessed directly from Hauseter Weg in order to minimize crossing points. The parking spaces (3 spaces) already located on the property under building law will also be newly created here.

    Recreation area with tree canopy
    A flat ramp leads to the higher and sheltered school and recreation area, which is the heart of the facility. The existing play equipment is arranged here under a tree canopy. Thanks to its central arrangement, it offers a high degree of clarity. The height difference to the entrance of the sports hall is overcome via a staircase and a barrier-free ramp.

    Green classroom
    In the north and east of the site, a green classroom, access to the existing football pitch and large meadow areas offer a variety of uses.

    Parking spaces
    Parking spaces for bicycles are provided directly at the entrance to the school and also in the passageway to the sports hall. The parking spaces required by building regulations for the use of the school for events are offered - as dual use - in the schoolyard or on gravel lawns next to the schoolyard.

  • Drawings

    Cuts
    Cuts
    A model photo of the winning design
    A model photo of the winning design

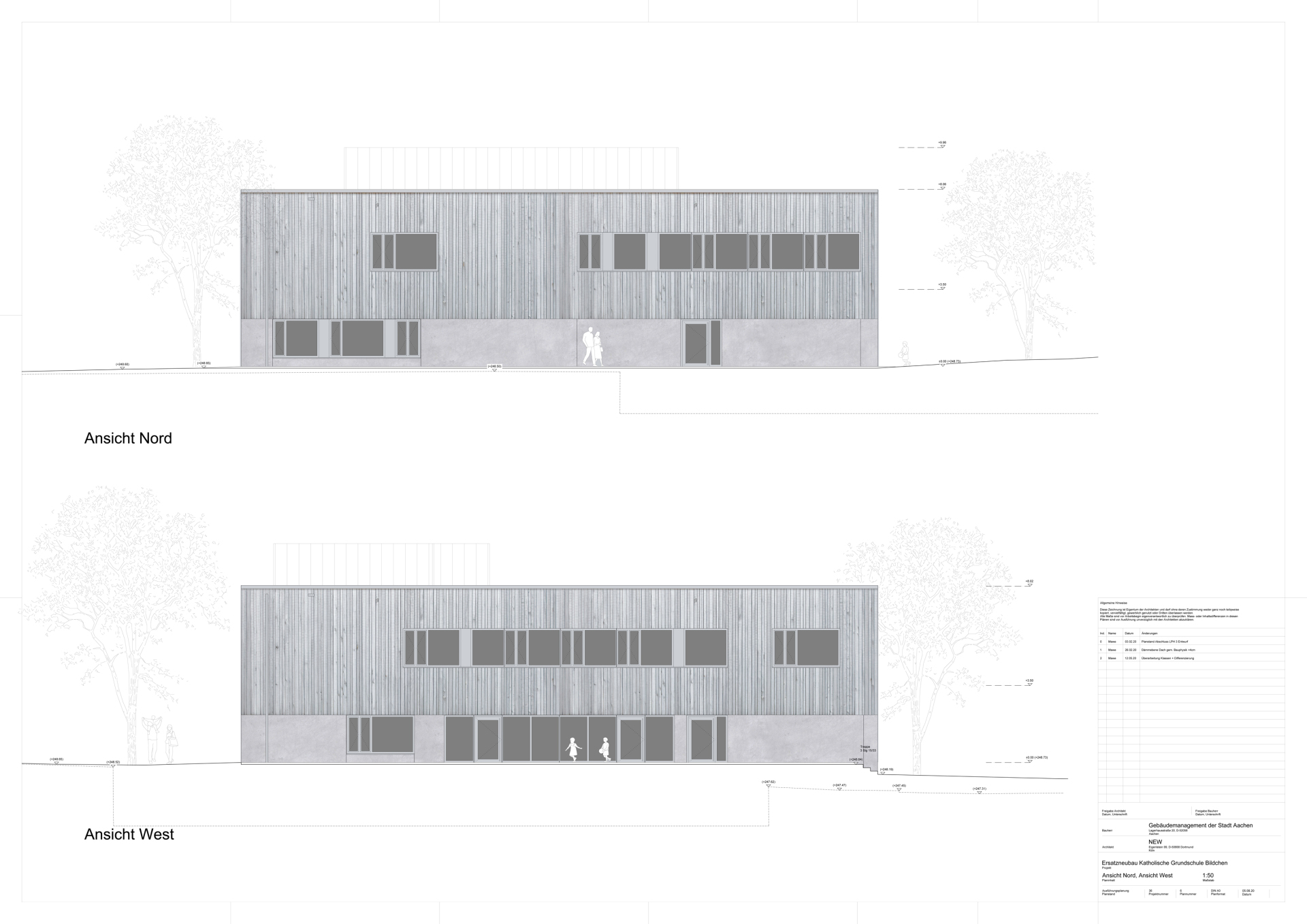

    Views
    Views
    Facade isomotrie
    Facade isomotrie

Help with accessibility

  • General

    We make every effort to ensure that our websites are accessible. You can find details on this in our accessibility statement. You can send us suggestions for improvement using our"Report a barrier" feedback form.

  • Font size

    To adjust the font size, please use the following key combinations:

    Larger

    Ctrl
    +

    Smaller

    Ctrl
  • Keyboard navigation

    Use TAB and SHIFT + TAB to navigate through next/previous links, form elements and buttons.

    Use ENTER to open links and interact with elements.
