Conversion of Inda-Gymnasium from G8 to G9

Extension building

Current: Construction site photos November 2025

In the time bar of the project phases, this project is in the construction phase.
Rendering view


Occasion and goal

On the basis of the 13th School Law Amendment Act passed by the NRW state parliament on July 11, 2018, the duration of the educational courses at secondary level I was revised. All eight municipal grammar schools in Aachen have decided to switch to nine years (G9). By the 2026/2027 school year, all year groups will once again be taught according to the new curricula.

  • Key data

    • Two-storey extension
    • Implementation during ongoing operations
    • 6 classrooms, 2 multifunctional rooms
    • 4 adjoining rooms
    • PV system
    • Heat supply: planned geothermal energy
    • Climate-neutral operation
    • increased Aachen standard
    • Start: February 2024


Construction site photos

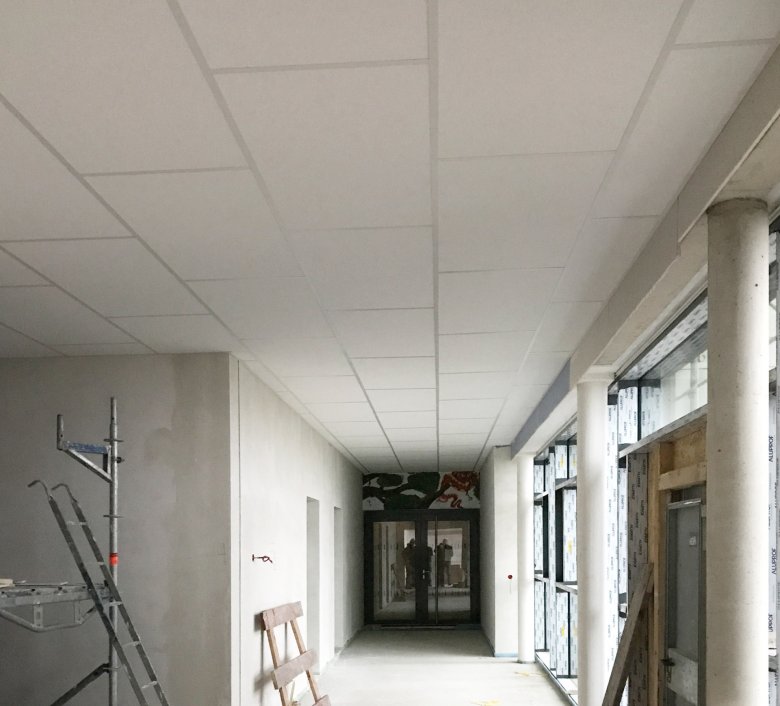

  • November 2025 Insulation curtain walling + fine installations Technology

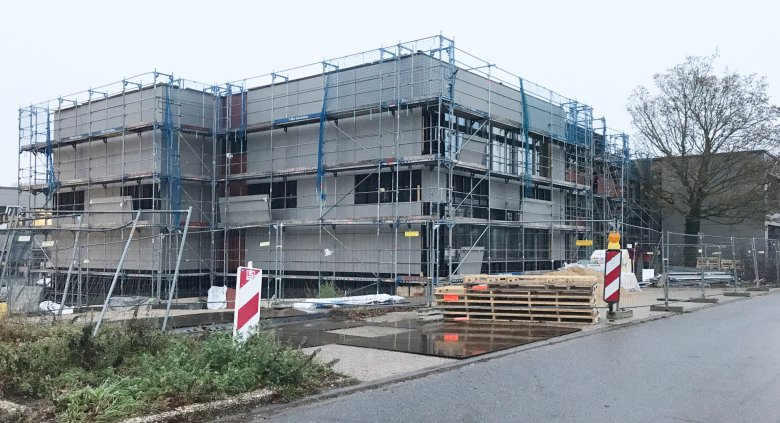

    The insulation work on the curtain walls has been completed. Cladding work with fiber cement panels will begin in week 46, 2025.
    The insulation work on the curtain walls has been completed. Cladding work with fiber cement panels will begin in week 46, 2025.

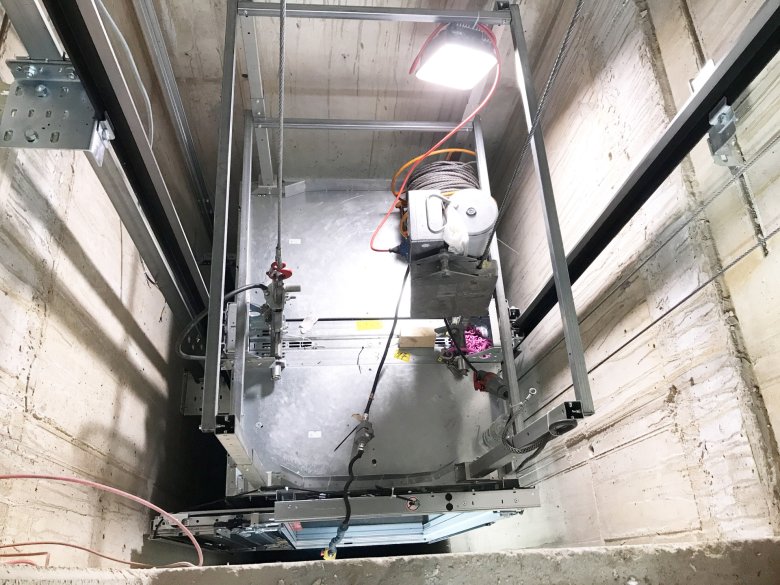

    The installation of the ventilation units and radiators is in progress.
    The installation of the ventilation units and radiators is in progress.


  • September 2025 Plaster + screed + curtain wall

    The installation of the PV system has been completed.
    The installation of the PV system has been completed.
    The plaster and screed work has been completed.
    The plaster and screed work has been completed.
    The curtain walling work has begun. The insulation is currently being installed.
    The curtain walling work has begun. The insulation is currently being installed.


  • August 2025 Photovoltaic modules + facades

    The window and façade work is progressing.
    The window and façade work is progressing.
    The window and façade work is currently underway.
    The window and façade work is currently underway.
    The photovoltaic modules were installed.
    The photovoltaic modules were installed.


  • July 2025 Photovoltaic system + staircase façade

    The roof sealing work was completed. The substructure for the photovoltaic elements was installed.
    The roof sealing work was completed. The substructure for the photovoltaic elements was installed.
    Work on the mullion and transom façades has started. The profiles for the stairwell glazing are currently being installed.
    Work on the mullion and transom façades has started. The profiles for the stairwell glazing are currently being installed.


  • June 2025 Shell construction + insulation + installations

    The structural work has been completed and the crane has been removed. The roof sealing work is underway.
    The structural work has been completed and the crane has been removed. The roof sealing work is underway.
    The laying of the gradient insulation and the waterproofing is in progress.
    The laying of the gradient insulation and the waterproofing is in progress.
    The installation work for the building services has made further progress.
    The installation work for the building services has made further progress.
  • May 2025 Installations + sealing

    Preparations were made for the installation work in the existing building to connect the extension.
    Preparations were made for the installation work in the existing building to connect the extension.
    The vapor barrier or emergency sealing was completed.
    The vapor barrier or emergency sealing was completed.
    The installation work for the building services in the new building has begun.
    The installation work for the building services in the new building has begun.
    The installation work for the building services in the new building has begun.
    The installation work for the building services in the new building has begun.


  • April 2025 Shell construction + stairs + attics

    The upper floor was completed.
    The upper floor was completed.
    The ceiling above the upper floor has been concreted and the parapets are being installed.
    The ceiling above the upper floor has been concreted and the parapets are being installed.
    The finished parts of the staircase were laid.
    The finished parts of the staircase were laid.
    The shell of the connecting corridor has been erected.
    The shell of the connecting corridor has been erected.
    The ceiling above the first floor was concreted.
    The ceiling above the first floor is reinforced.
  • February 2025 Masonry walls

    The masonry walls on the ground floor are erected.
    The masonry walls on the ground floor are erected.


  • January 2025 Prefabricated walls

    The prefabricated walls on the ground floor are installed.
    The prefabricated walls on the ground floor are installed.
    The existing balcony will be demolished.
    The existing balcony will be demolished.


  • December 2024 Floor panels

    The floor slab of the ground floor is concreted.
    The floor slab of the ground floor is concreted.
    The reinforcement of the ground floor slab is being prepared.
    The reinforcement of the ground floor slab is being prepared.


  • October 2024 Shell construction basement

    The ceiling above the basement is concreted.
    The ceiling above the basement is concreted.
    The semi-prefabricated walls of the basement have been completed.
    The semi-prefabricated walls of the basement have been completed.
    The floor slab of the basement has been concreted.
    The floor slab of the basement has been concreted.


  • July 2024 Site clearance

    Site clearance July 2024
    The construction site has been cleared for the explosive ordnance survey.
  • February 2024 Tree felling

    Tree felling February 2024
    Tree felling in February 2024

Architectural concept

  • Two-storey extension with partial basement on building wing 2
  • Architecture and design language based on the existing building with a colorful accent
  • Room program: 6 classrooms, 2 multifunctional rooms, 2 teaching materials rooms, building services room, storage room
  • Glazed connecting element for barrier-free access to the new building and building tracts 1 and 2 with an elevator
  • Consideration of a PV system on the new roof area, partial roof areas with a green roof
  • Redesign of outdoor facilities with replacement planting

Site plan of the extension including open space planning.

Energy concept

  • Compact design
  • Structural thermal insulation in accordance with the increased Aachen standard
  • Installation of a PV system on the roof, climate neutrality in operation
  • Planned conversion of the heat supply to geothermal energy

Further project information

  • Basic data inventory

    The Inda-Gymnasium includes the multi-winged main building from 1973, a science extension from 2007 and a sports hall. Around 1,350 pupils attend the 5-form grammar school.

  • Building concept

    The planned extension will be built between building wing 2 and the sports hall at Romerich.

    In order to be able to carry out the work while the school is open, four classes have to be moved out of wing 2 of the building

Help with accessibility

  • General

    We make every effort to ensure that our websites are accessible. You can find details on this in our accessibility statement. You can send us suggestions for improvement using our"Report a barrier" feedback form.

  • Font size

    To adjust the font size, please use the following key combinations:

    Larger

    Ctrl
    +

    Smaller

    Ctrl
  • Keyboard navigation

    Use TAB and SHIFT + TAB to navigate through next/previous links, form elements and buttons.

    Use ENTER to open links and interact with elements.
