New outdoor pool building Hangeweiher

New building with changing rooms, sanitary facilities, office, social and living areas

In the time bar of the project phases, this project is in the construction phase.
Prospects for new outdoor pool building

Occasion and goal

The Hangeweiher outdoor pool is the only outdoor pool in Aachen and the surrounding area and is an indispensable leisure facility for the city of Aachen. In order to ensure the continued existence of the outdated outdoor pool, the pool facilities and the associated pool technology have already been renovated in the 1st and 2nd construction phases.

The existing outdoor pool building was an oversized complex of buildings with various significant structural and constructional defects. In order to completely transform it into a modern outdoor pool that meets today's requirements, a new replacement building, including a new entrance and ticket office area, will be erected once the old building has been cleaned up and demolished.

  • Key data

    • Start of implementation 2023
    • Expected completion: 2026
    • Net floor space: approx. 550m²
    • Gross volume: approx. 2,900m²
    • Architects: Kaiser Schweitzer Architects

Construction site photos

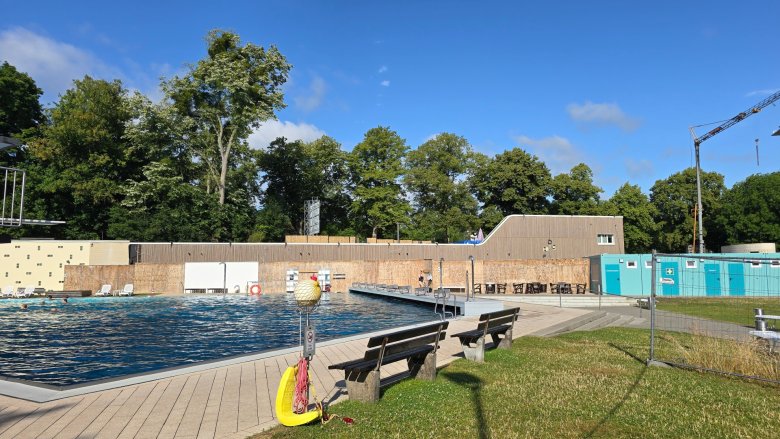

  • April 2025

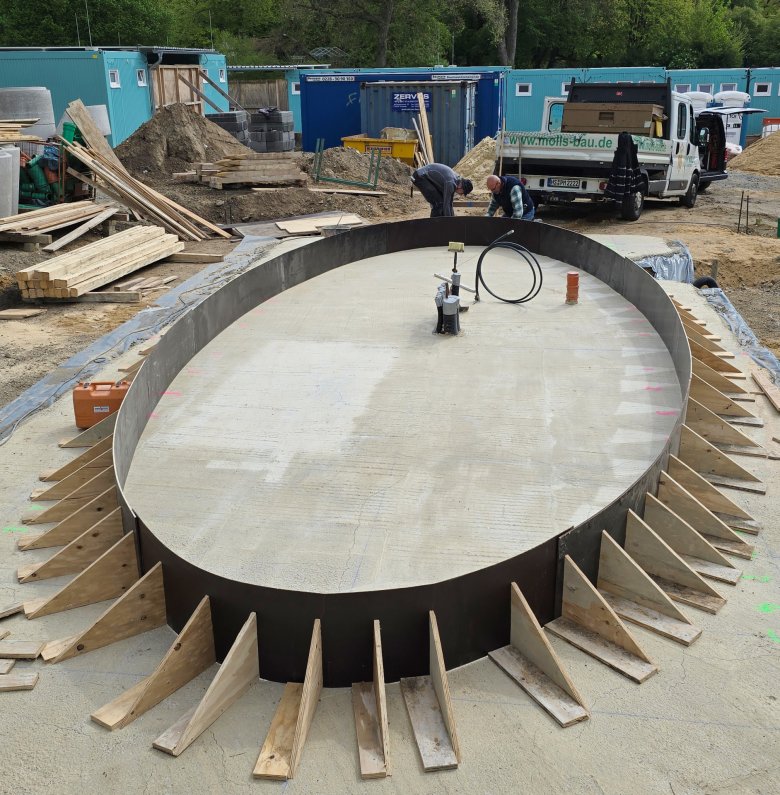

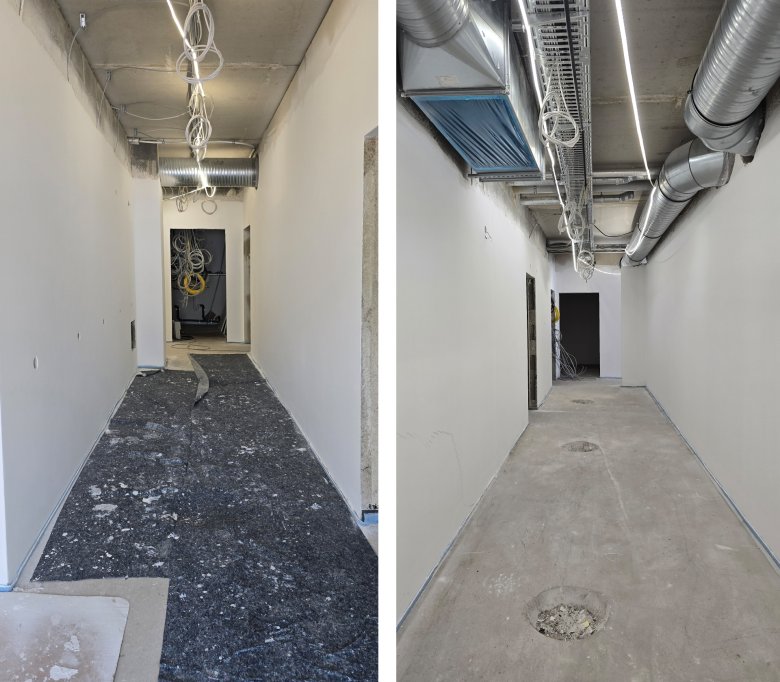

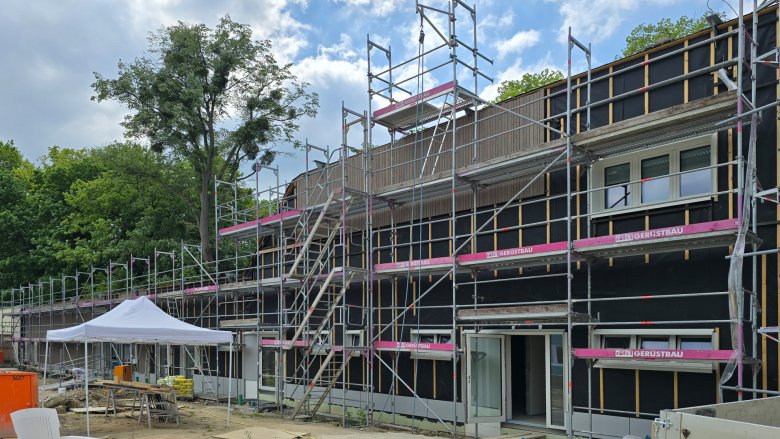

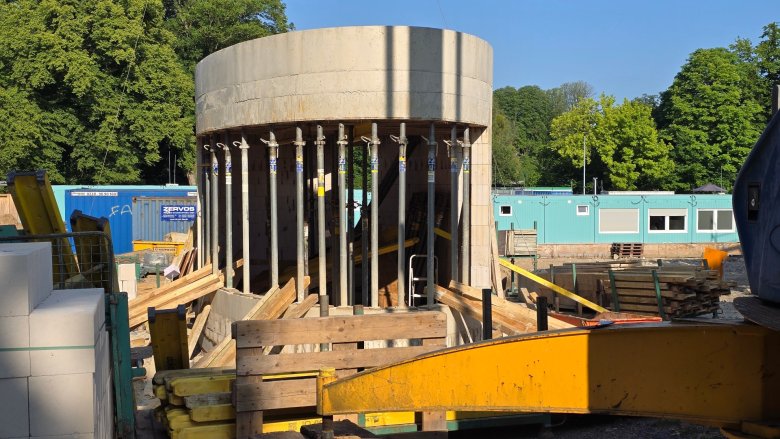

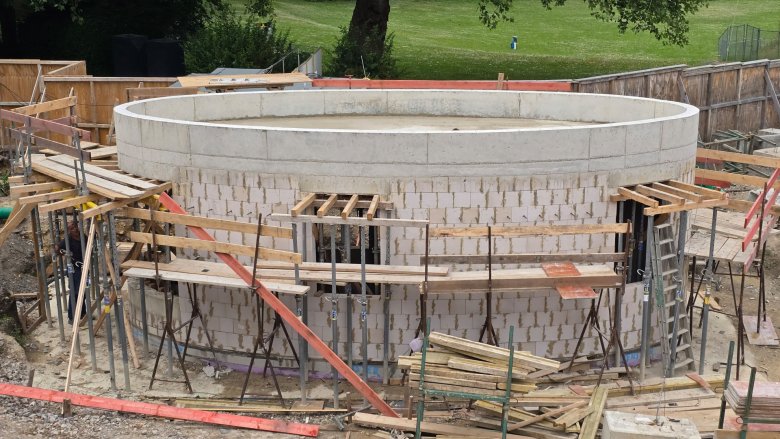

    Shell construction work for the ticket office
    Shell construction work for the ticket office
    The office apartment was completed.
    The office apartment was completed.

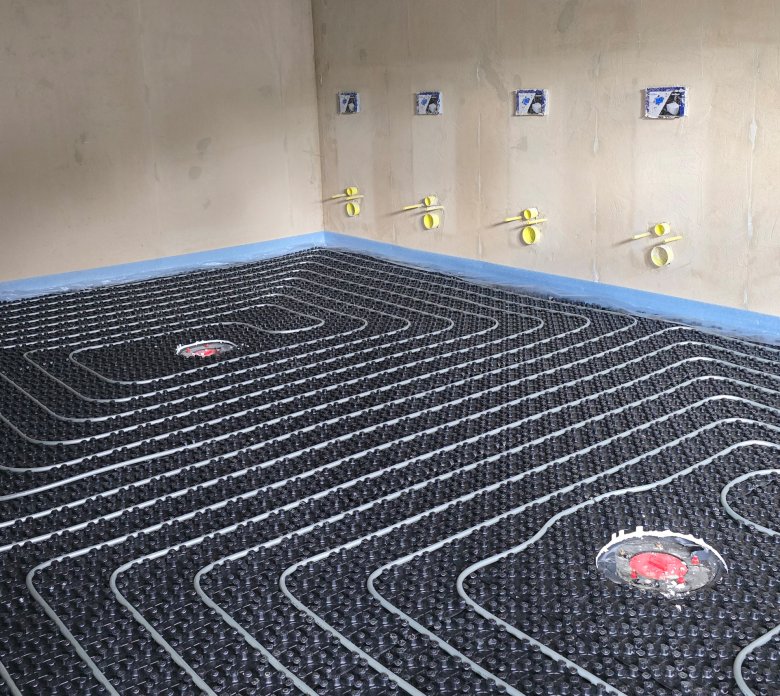

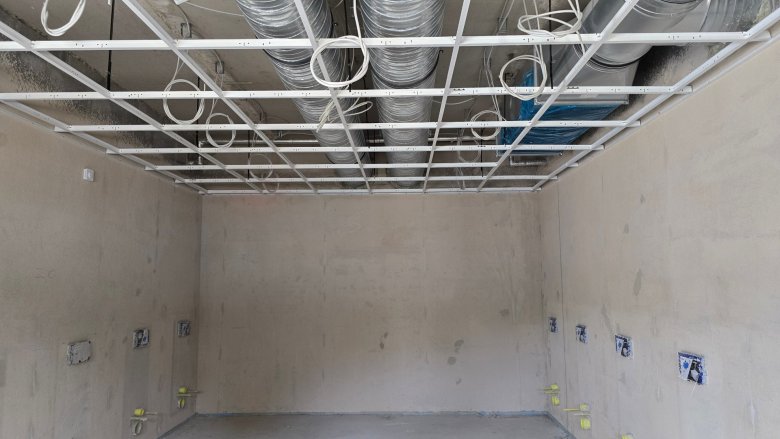

    The underfloor heating in the WC areas is in progress.
    The underfloor heating in the WC areas is in progress.

  • March 2025 Plastering work

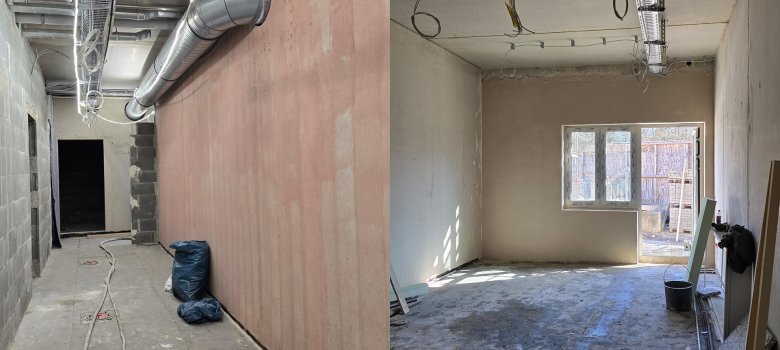

    The preparatory work for the plastering work in the shower area has been completed.
    The preparatory work for the plastering work in the shower area has been completed.

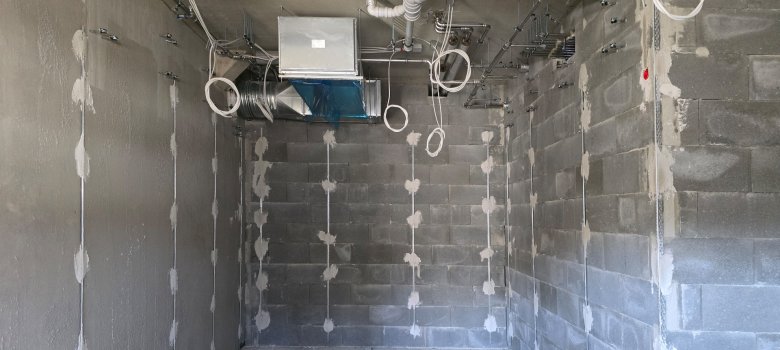

    The picture shows preparatory work for the plastering in the corridor area and plastering work in the staff room.
    The picture shows preparatory work for the plastering in the corridor area and plastering work in the staff room.

  • December 2024

    The substrate layer of the green roof was created.
    The substrate layer of the green roof was created.

    The screed in the apartment has been laid.
    The screed in the apartment has been laid.
  • October 2024

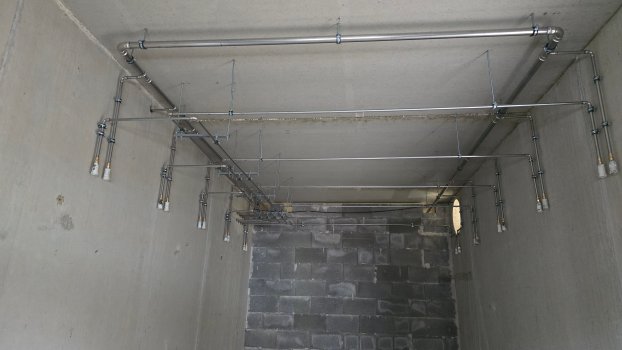

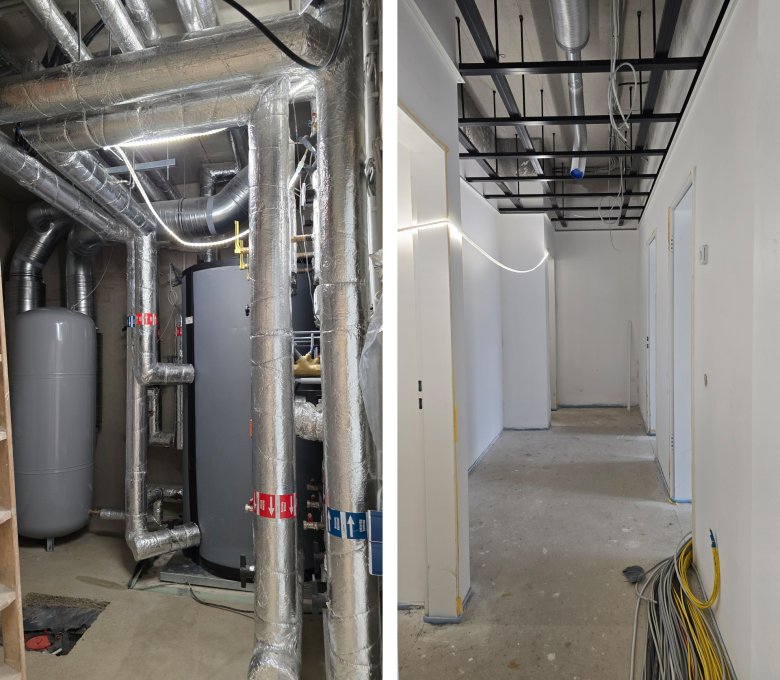

    The shower installations.
    The shower installations.

    The drywall substructure in the apartment has been installed.
    The drywall substructure in the apartment has been installed.

  • June to August 2024: Shell construction

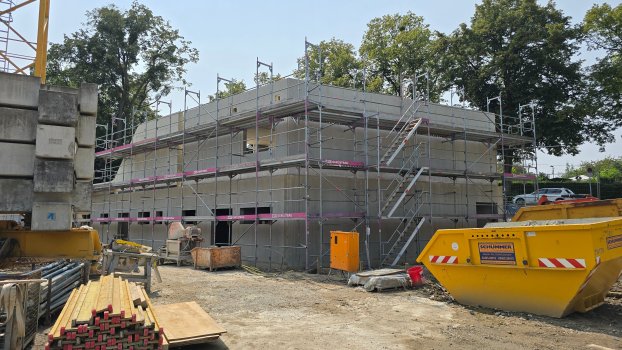

    Walls upper floor
    Walls upper floor

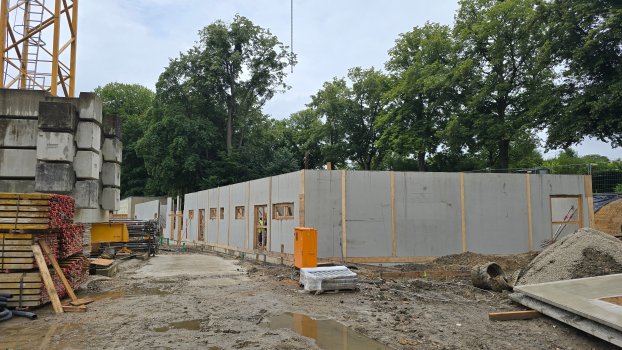

    The ground floor walls have been constructed.
    The ground floor walls have been constructed.

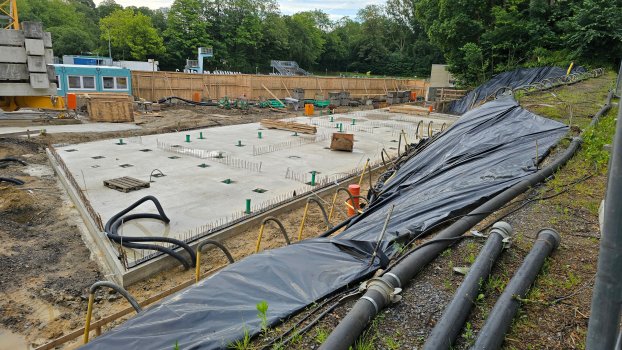

    Base plate
    Base plate

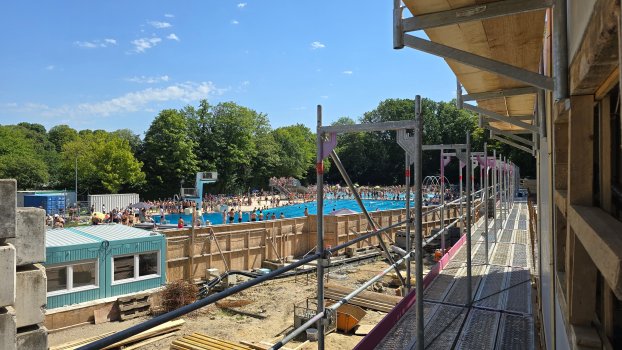

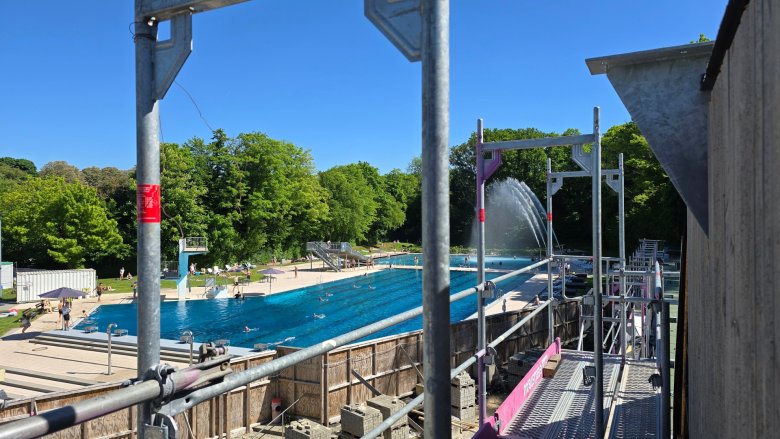

    The outdoor pool is open despite the major construction site.
    The outdoor pool is open despite the major construction site.

  • March 2024: Start of the shell construction work

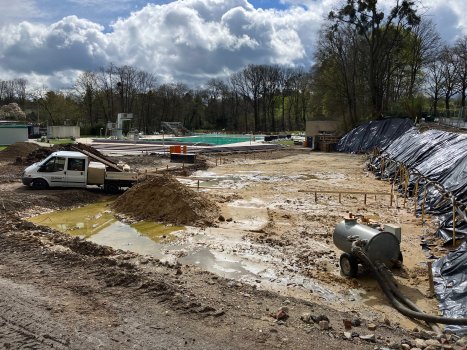

    Start of the shell construction
    Start of the shell construction

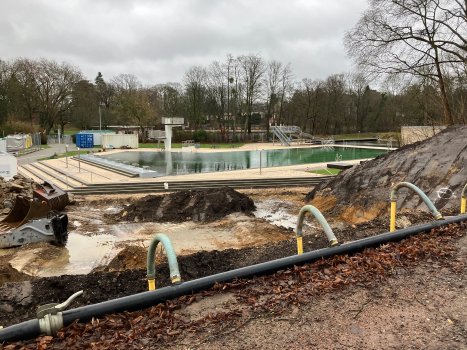

    Construction site in the rain
    Construction site in the rain
  • November 2023: Dismantling

    Sorting the demolition materials
    Sorting the demolition materials

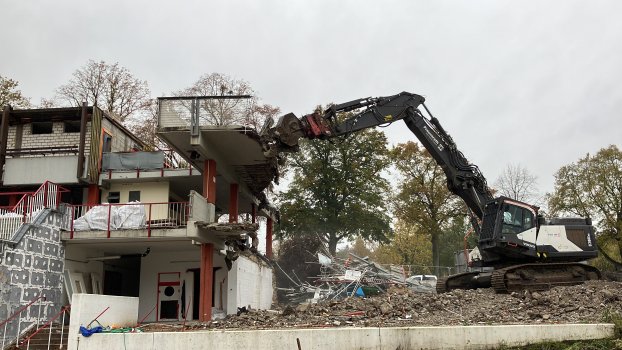

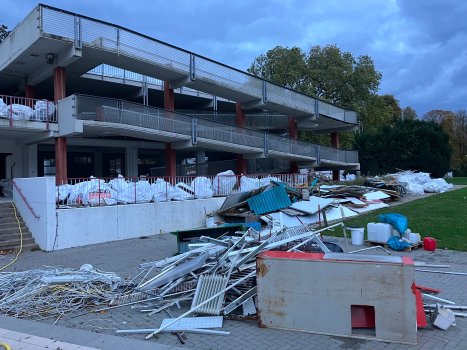

    Dismantling work with heavy equipment
    Dismantling work with heavy equipment
  • Stock photos

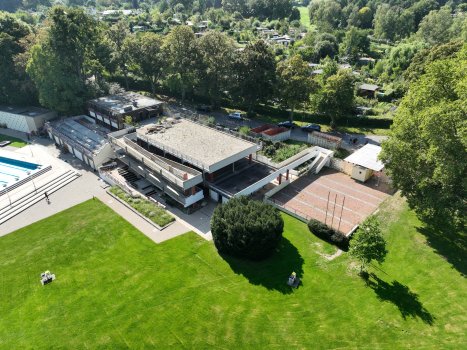

    Aerial photo inventory
    Aerial photo inventory

    Existing image of the ramp system

Concept

A compact new building with only one or two storeys will be erected.

Solid construction and green roof:
The solid construction building with a timber façade is nestled into the slope facing the street, utilizing the topography of the terrain so that the green roof on the first floor continues the landscape.

Energy roof:
On the street side, only the apartment for the bathroom management is visible from the building, whose green roof is adjoined to the north by the "energy roof" made of translucent photovoltaic modules.

Entrance area:
The "energy roof" marks the entrance area with ticket office below due to the sloping terrain of the street Am Hangeweiher.

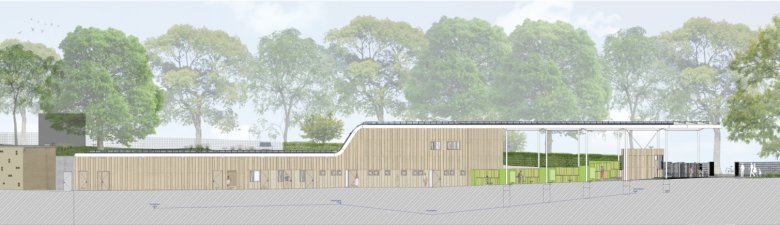

Longitudinal view
Longitudinal view

Project information

  • Uses

    First floor:
    On the first floor, there is a wheelchair-accessible area, shared changing rooms, sanitary facilities, showers, offices and social rooms for employees and storage. All functional areas are barrier-free.

    Upper floor:
    An apartment for the bathroom management is planned for the upper floor. An "energy roof" made of photovoltaic elements characterizes the newly arranged entrance area with a new ticket office and covers the open-air changing rooms with lockers located between the ticket office and the building.

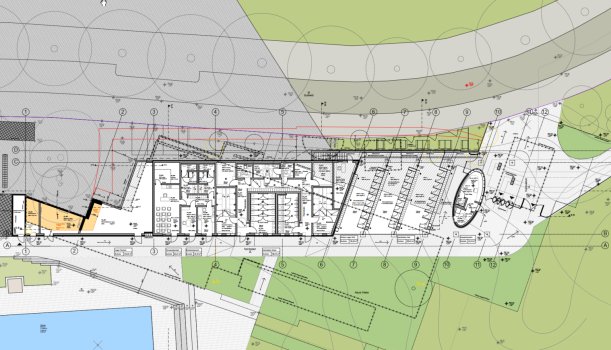

    First floor plan
    First floor plan

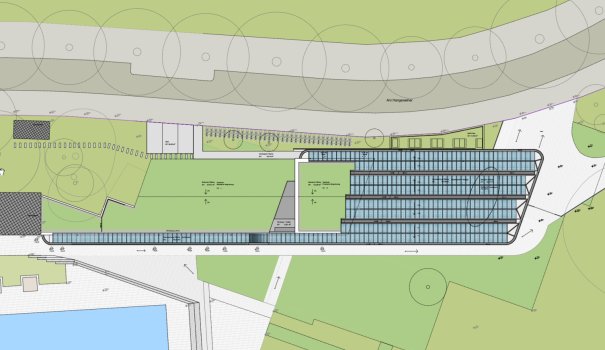

    Roof supervision
    Roof supervision
  • Outdoor facilities

    Sunbathing lawn and forecourt:
    As the planned building will be constructed closer to the road and smaller than the old building, the sunbathing lawn will be slightly larger. The forecourt in front of the ticket office will be redesigned with tactile strips and lighting, and modern ticket machines will be installed in a decentralized location.
    In addition to baby carriage and wheelchair access at the ticket office, turnstile gates with electronic access control will allow swift entry to the outdoor pool area.

    Bicycle parking spaces:
    New, additional bicycle and cargo bike parking spaces are being created along the building on the street.

  • Key data

    • Net room area NRF: approx. 550 m²
    • Gross cubic capacity BRI: approx. 2,900 m³
    • Start of execution: September 2023
    • Expected completion: 2025
    • Architects: Kaiser Schweitzer Architects
    • Funds required: approx. € 6.8 million
    • Funding program: € 1,485,000 via the federal program "Renovation of municipal facilities in the areas of sport, youth and culture" of the Federal Ministry of Housing, Urban Development and Construction
  • Drawings

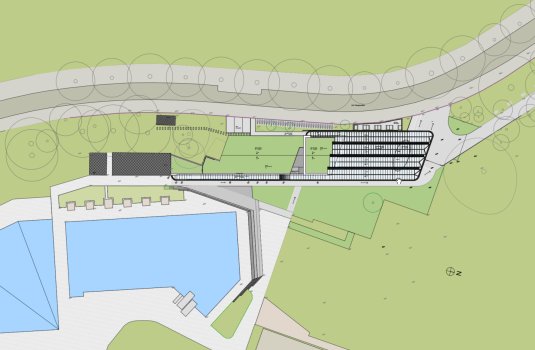

    Site plan
    Site plan

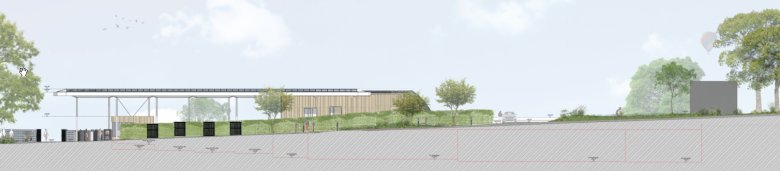

    Street view
    Street view

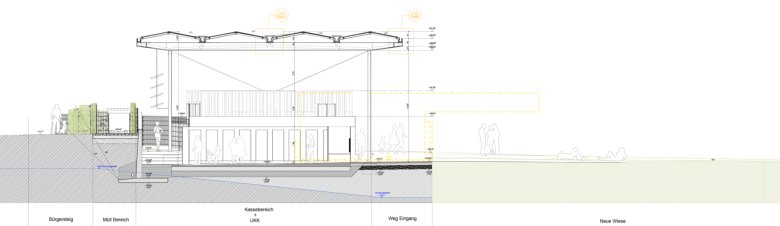

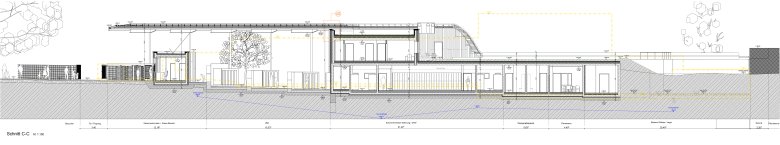

    Longitudinal cut
    Longitudinal cut
    North view
    North view
    Cross section
    Cross section
    Longitudinal view
    Longitudinal view
    First floor plan
    First floor plan
    Roof supervision
    Roof supervision

Promotion

The project is being funded with €1,485,000 from the Federal Ministry of Housing, Urban Development and Construction's "Renovation of municipal facilities in the areas of sport, youth and culture" funding program.

Sponsor

Help with accessibility

  • General

    We make every effort to ensure that our websites are accessible. You can find details on this in our accessibility statement. You can send us suggestions for improvement using our"Report a barrier" feedback form.

  • Font size

    To adjust the font size, please use the following key combinations:

    Larger

    Ctrl
    +

    Smaller

    Ctrl
  • Keyboard navigation

    Use TAB and SHIFT + TAB to navigate through next/previous links, form elements and buttons.

    Use ENTER to open links and interact with elements.
